Progress Report #01 | Q2 2022
Introduction
•Arrow Monaco has been engaged to review the status and quality of the build of the new build Custom Line 42m hull number 10.
•The outfitting is taking place at the Custom Line/Ferretti facilities in Ancona.

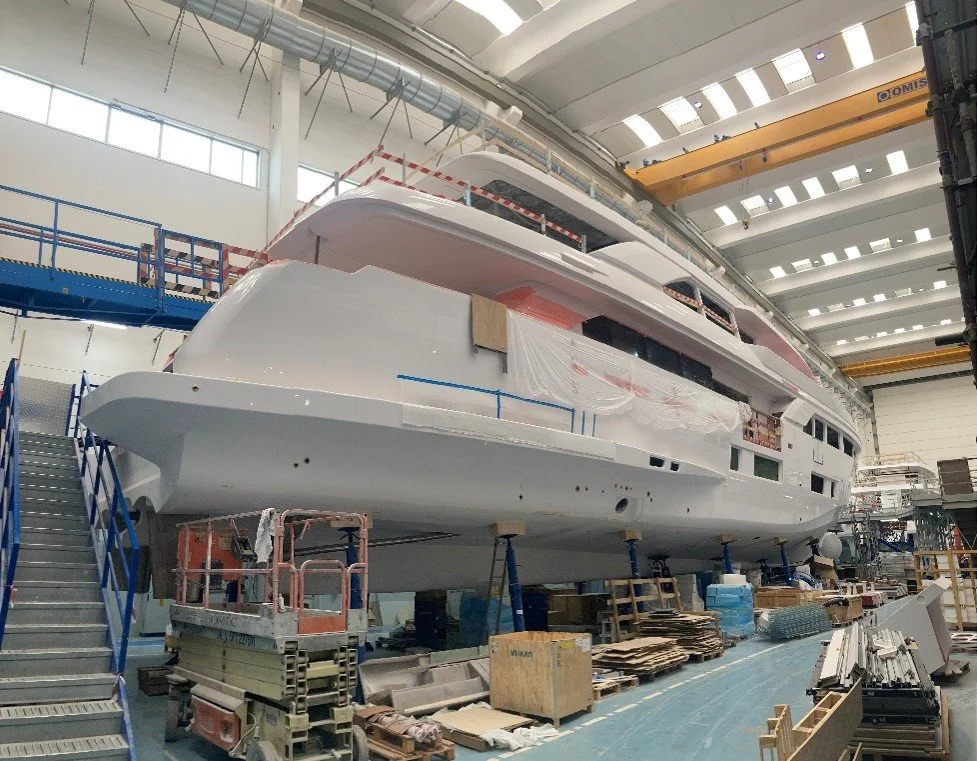

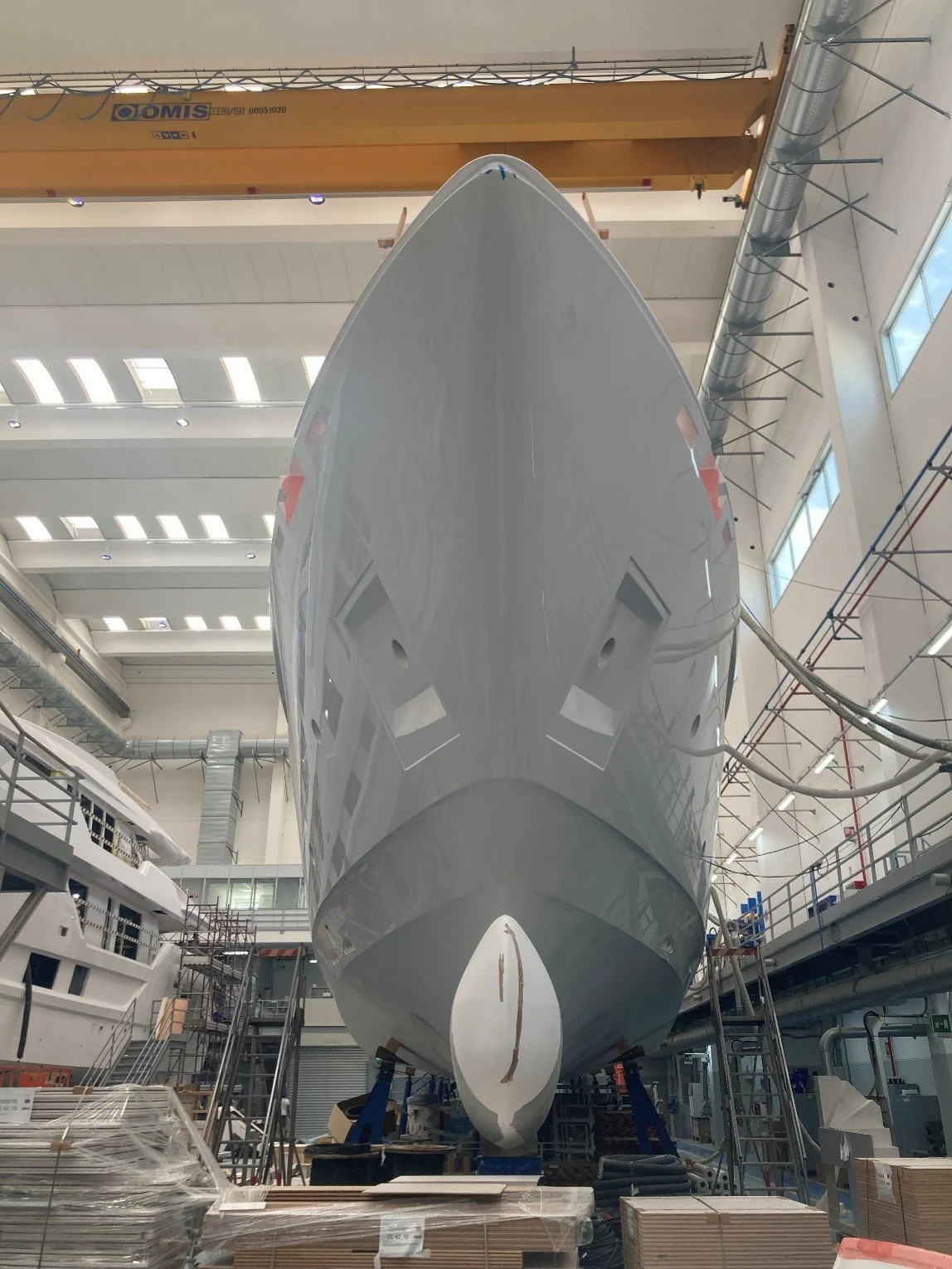

•The following report illustrates the status of the build as of the 25th of June 2022 when the vessel was visited.

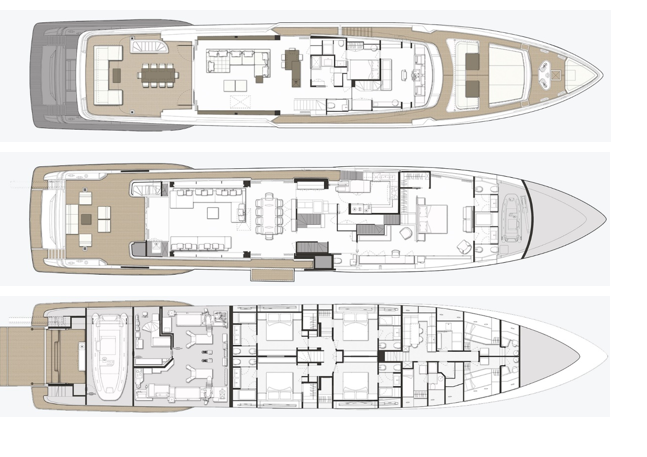

•The finished vessel will have the following arrangement:
Conclusion

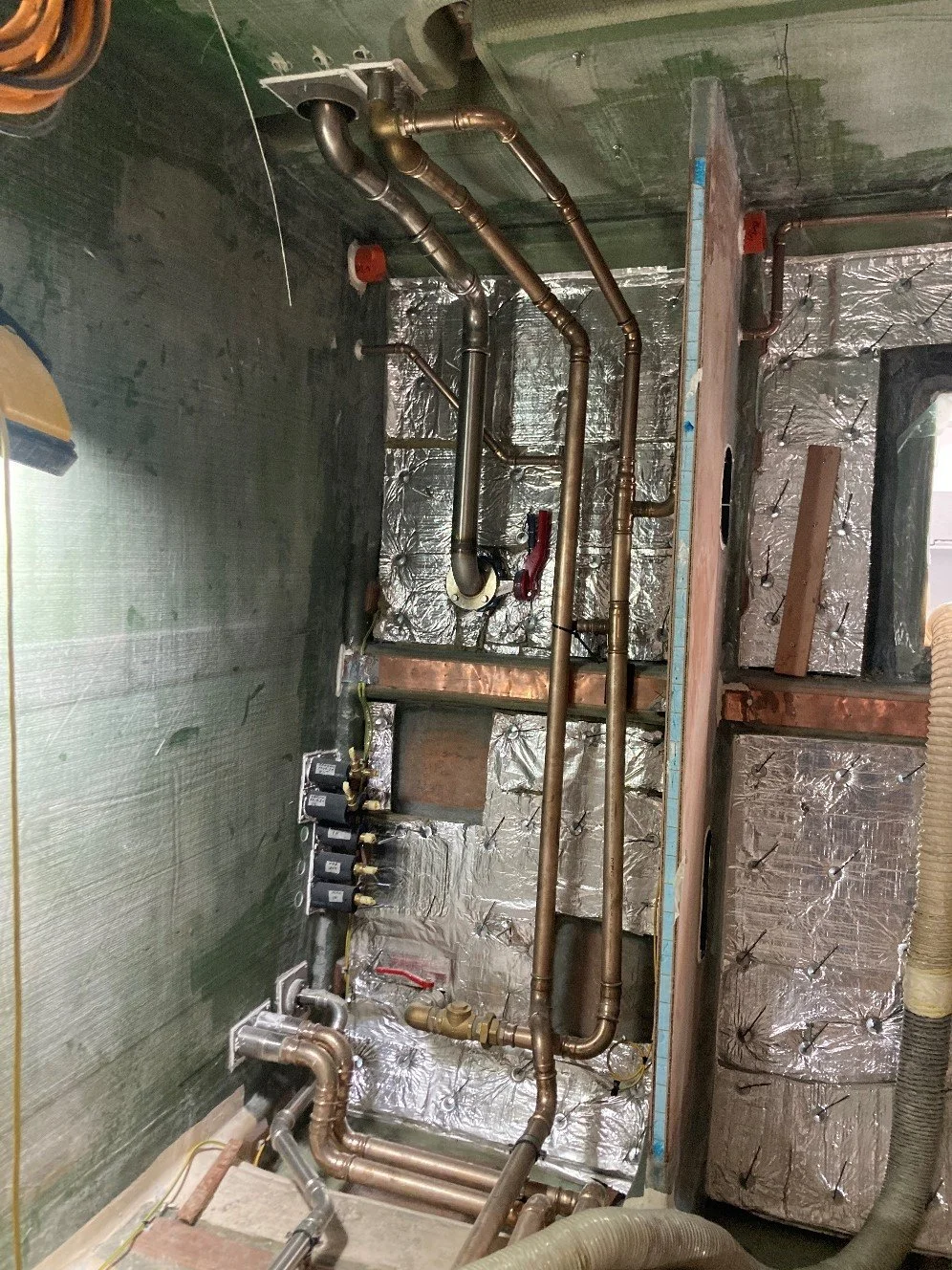

•Progress of the vessel is being monitored as per the table here attached. The status will be monitored on a fortnight basis,
•As this moment in time we do not envisage any critical items which could lead to any delays in delivery,
•We will monitor the current chain supply crisis and its repercussions on delivery of critical items on board.
