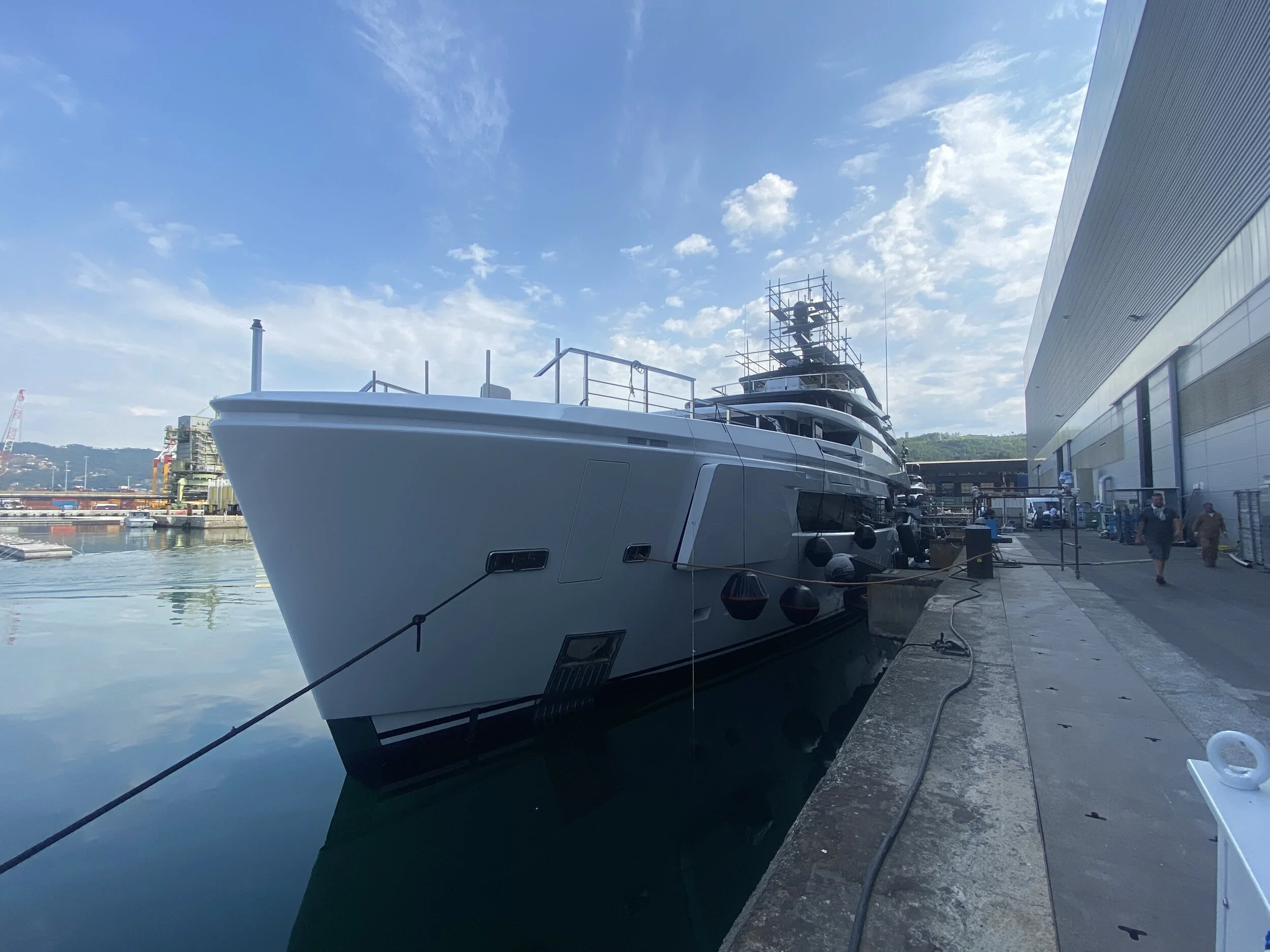

exterior

15 JULY 2020

exterior progress update

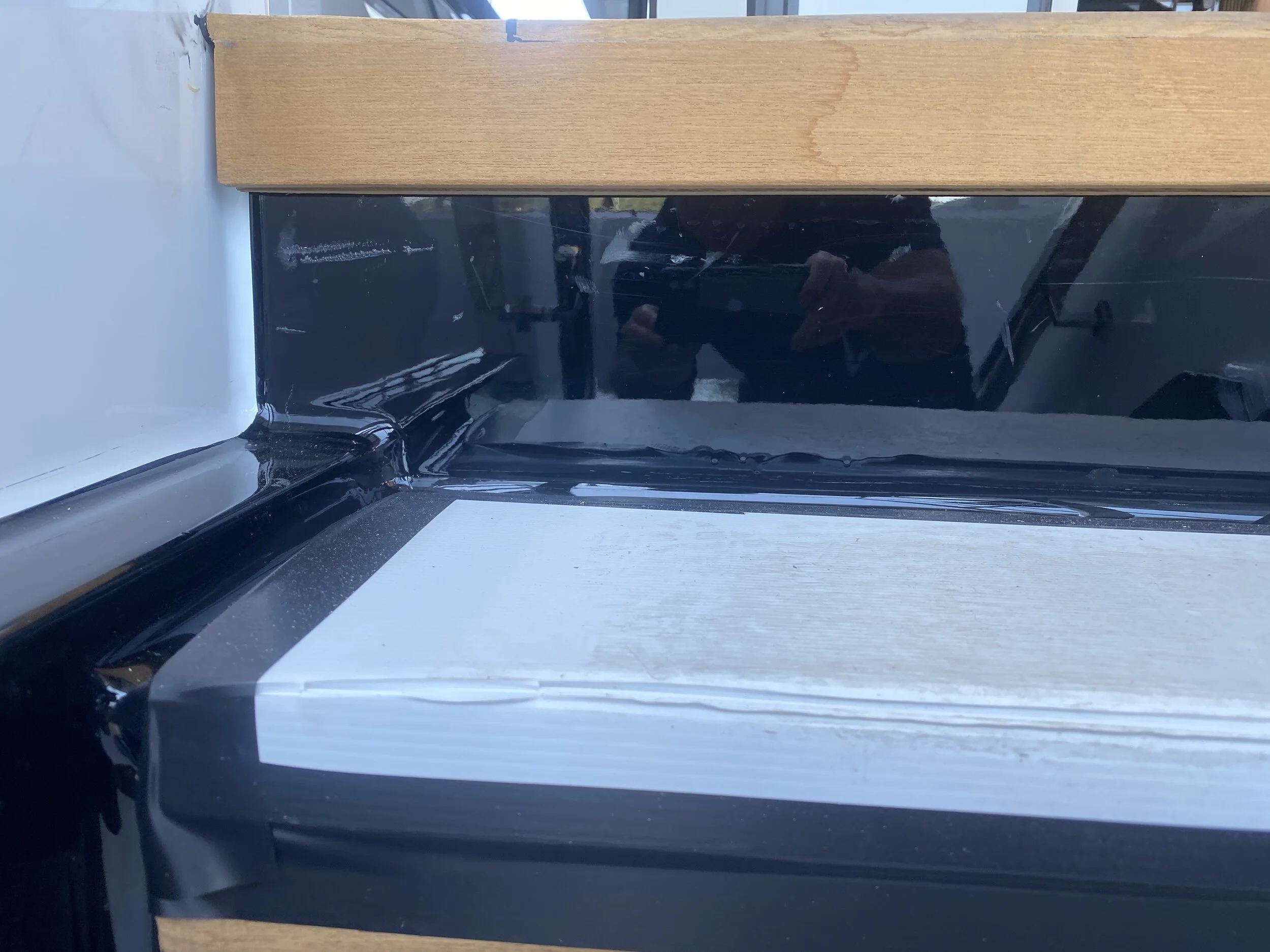

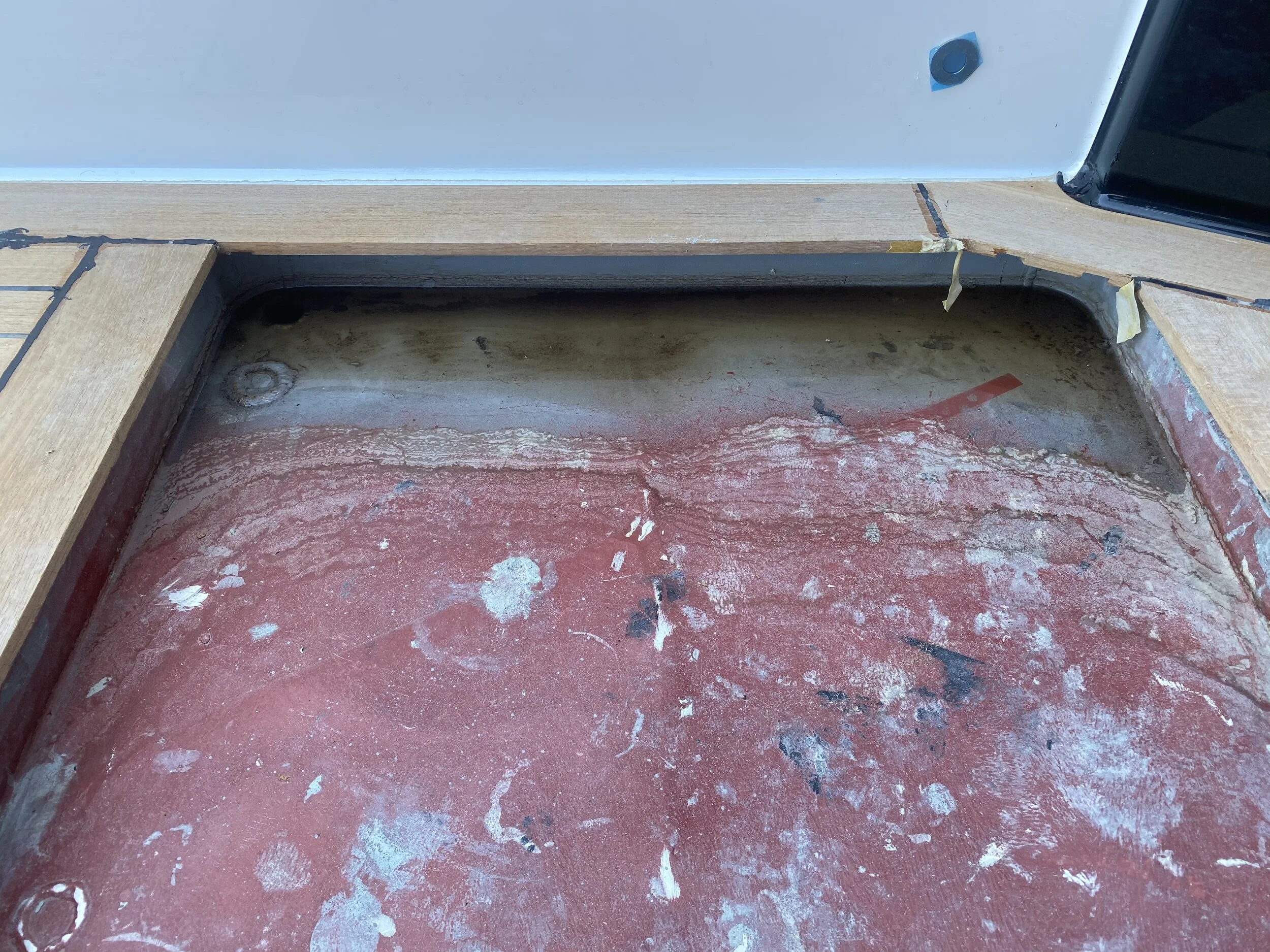

corrections required on black paint and sag in top coat

Wing station installed, deck to be sanded, this will remove all fouling

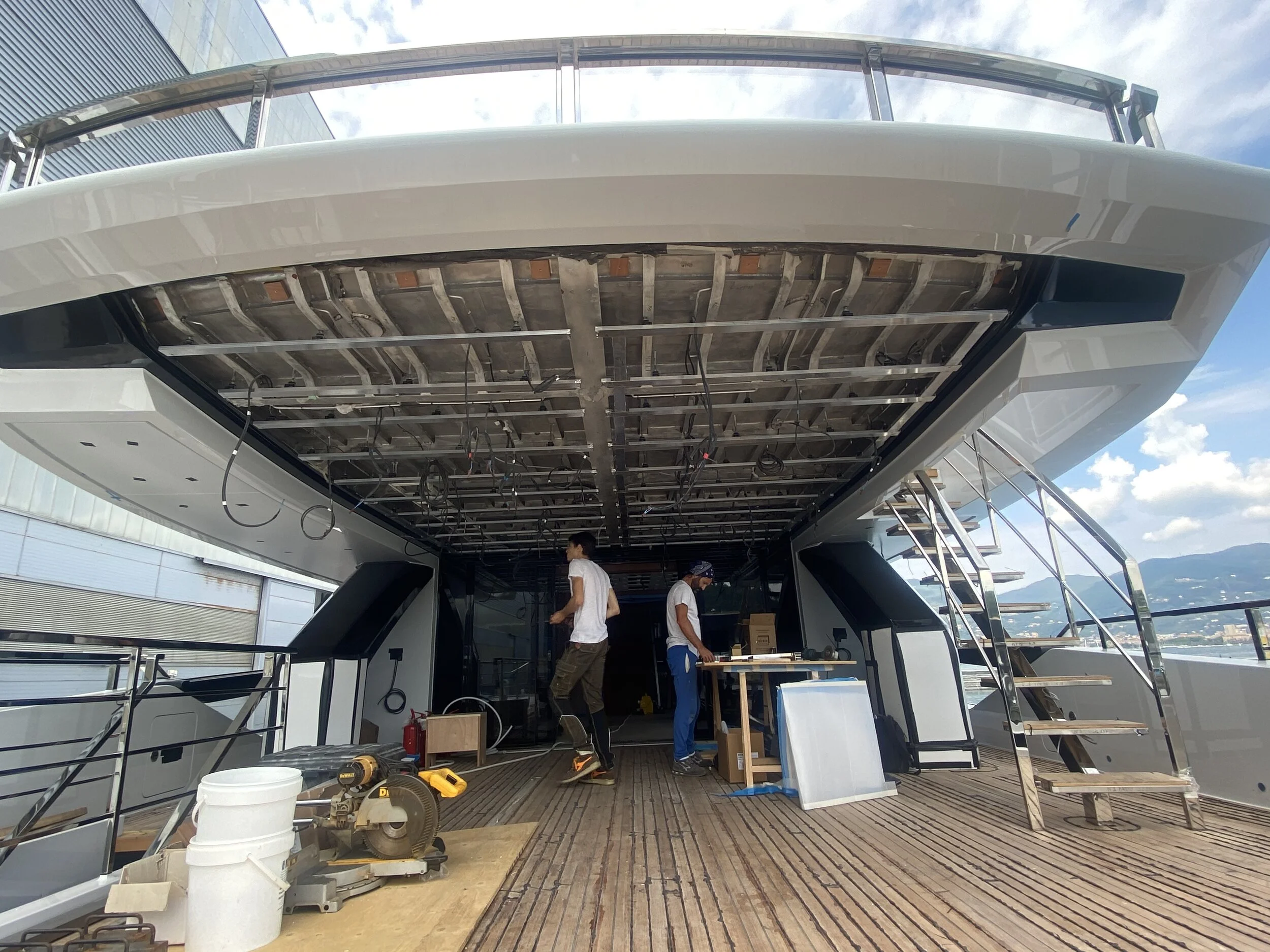

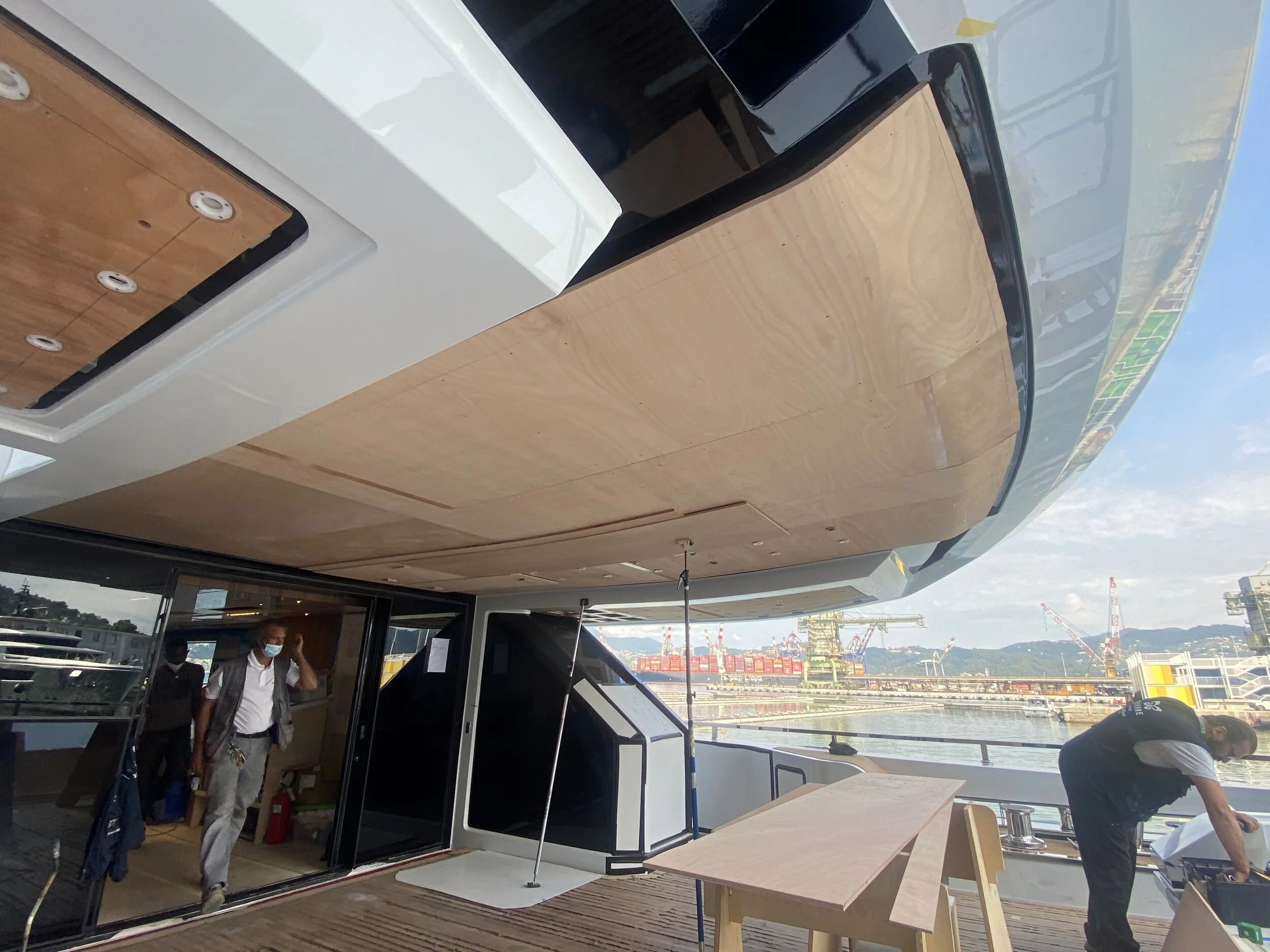

Deck head mock up for teak overheads

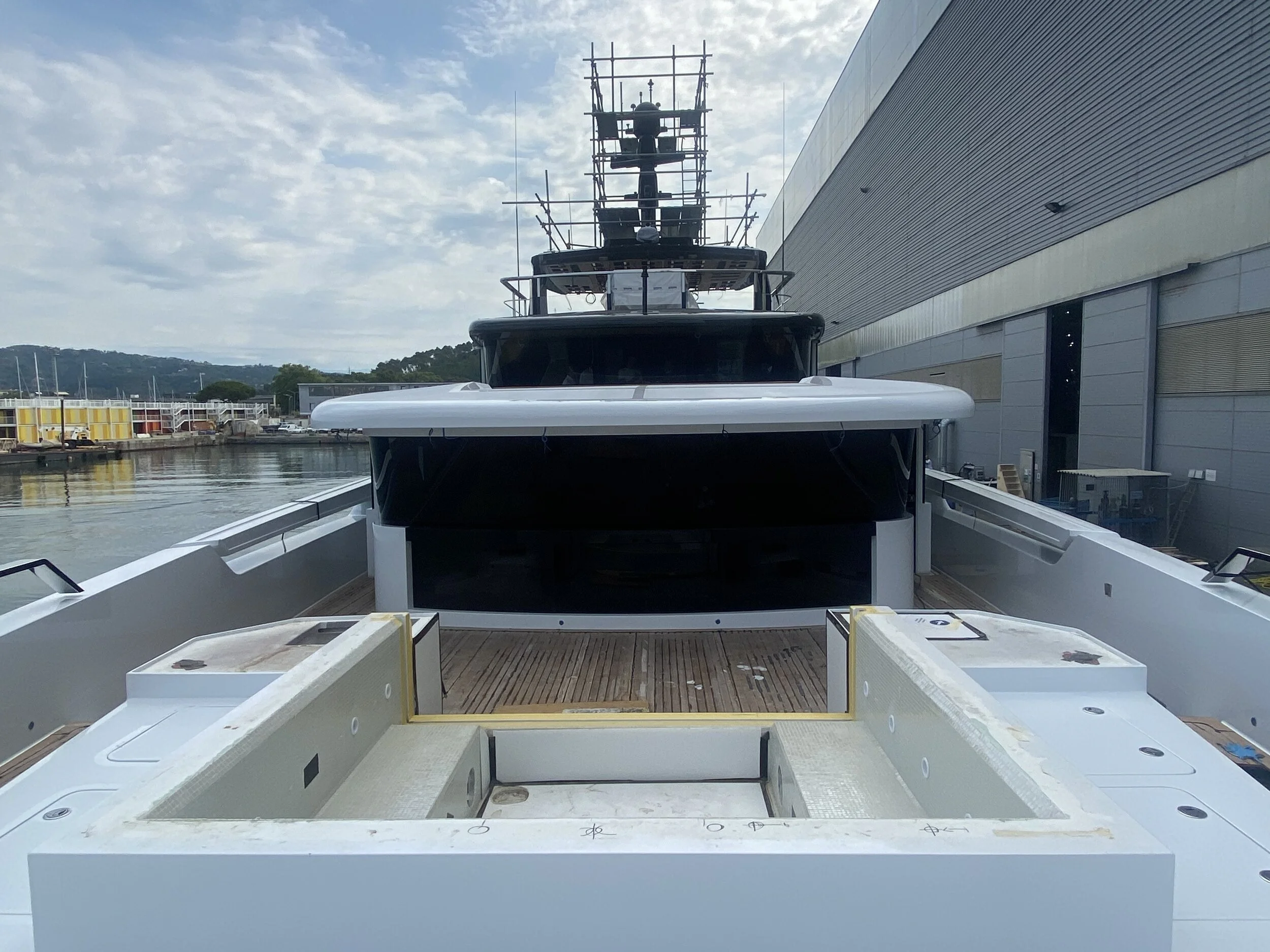

Transom door in the down position

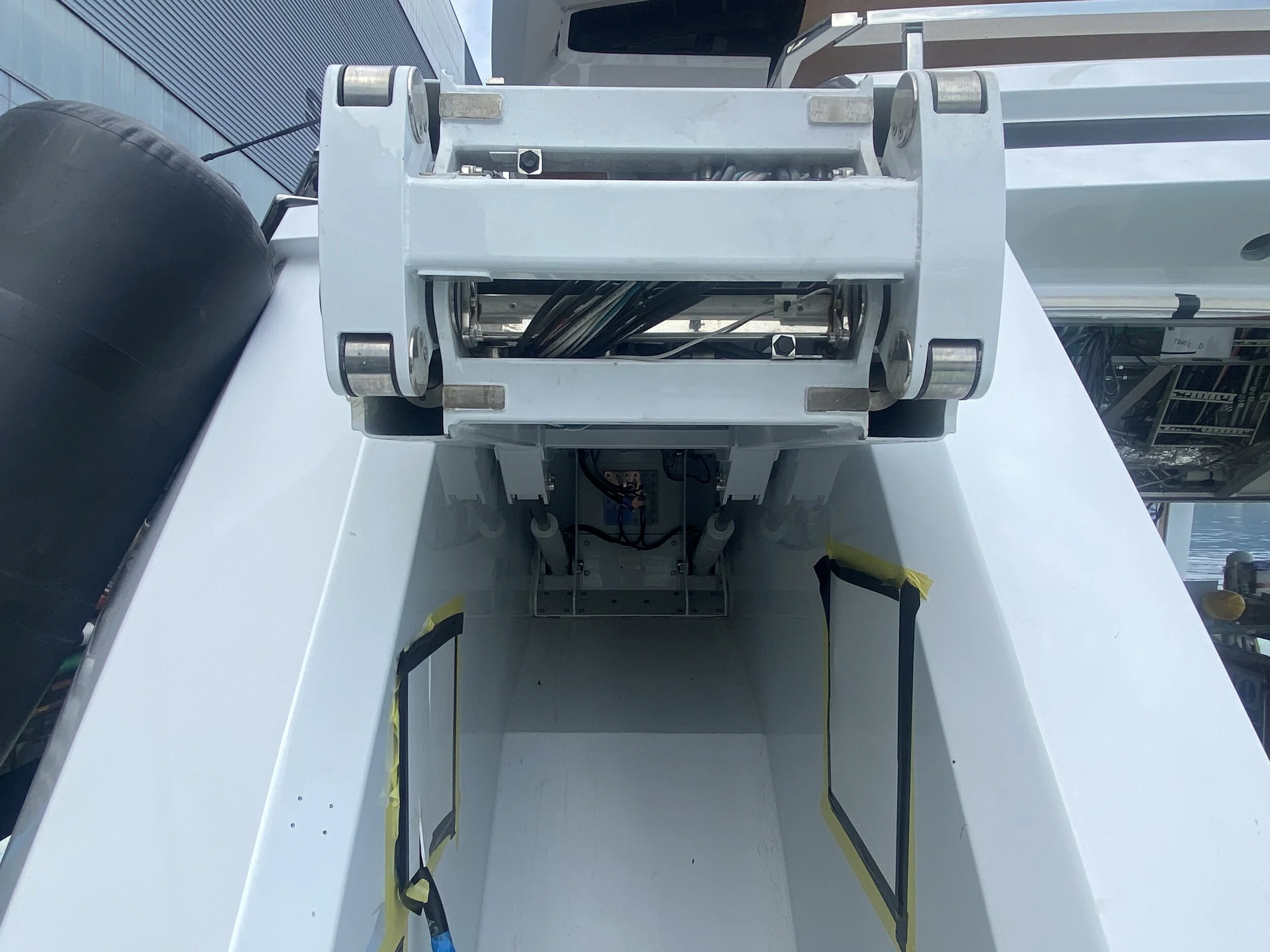

Deck head mounts yet to be installed

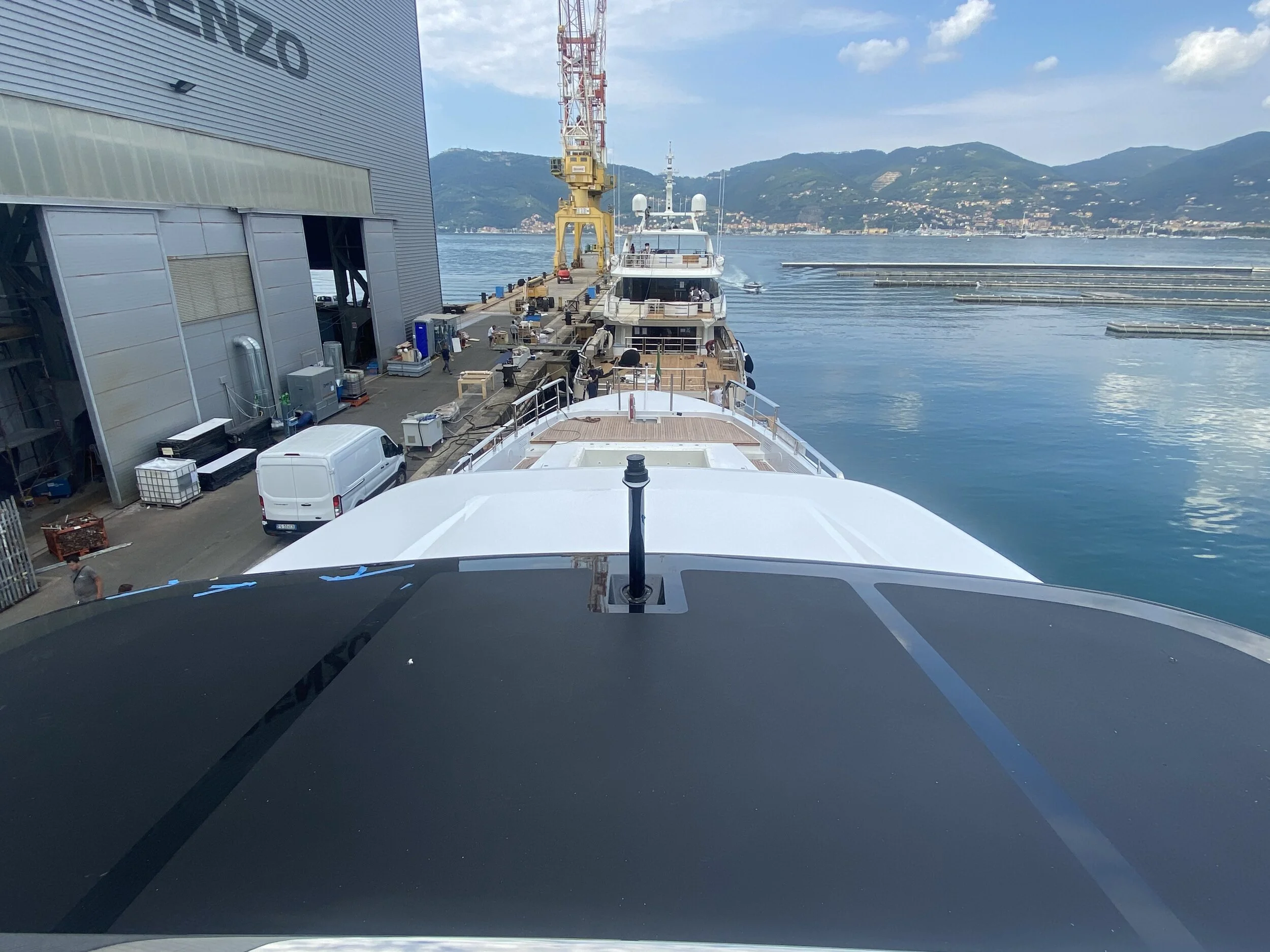

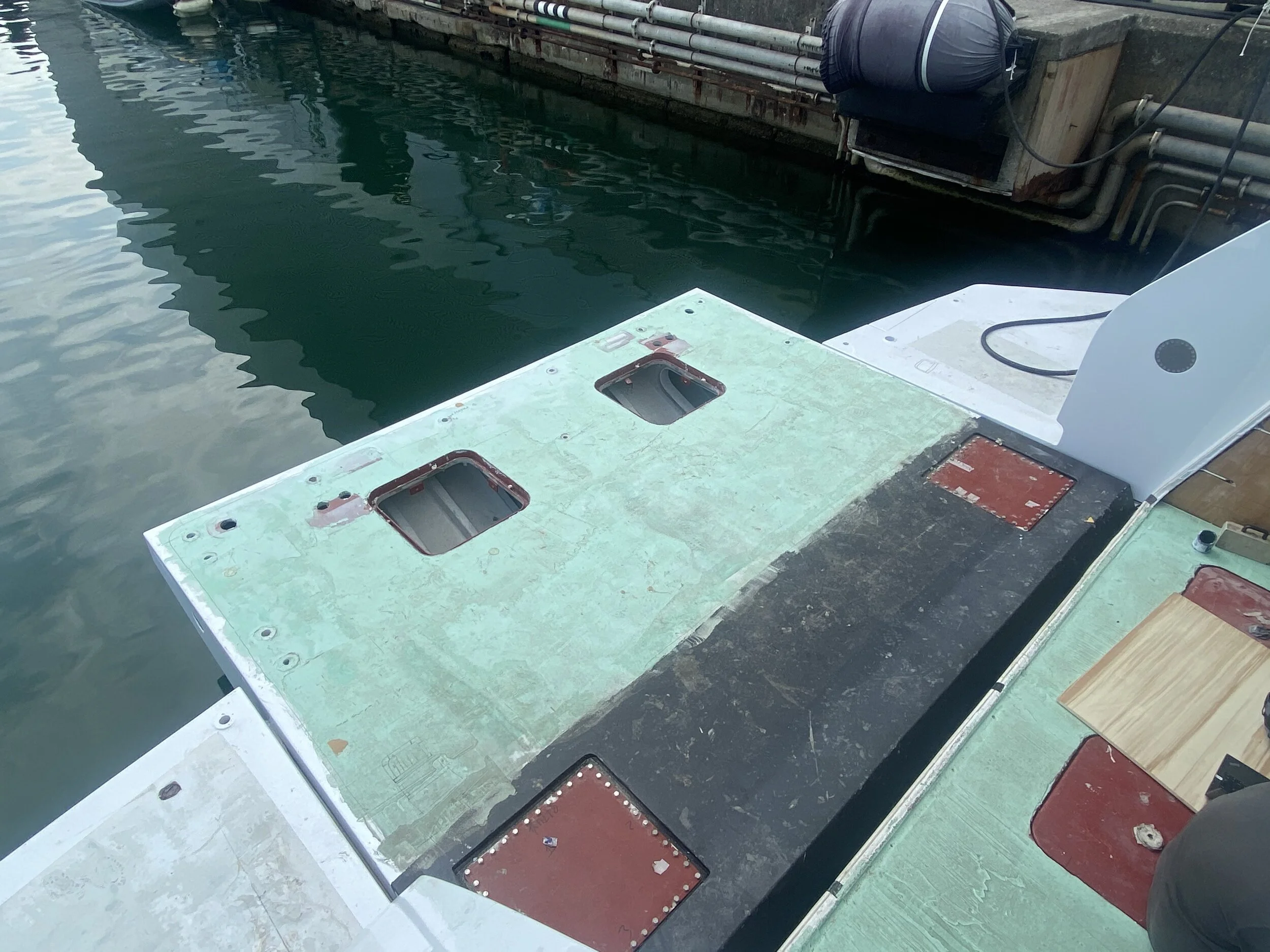

Non skid painted on the bridge roof

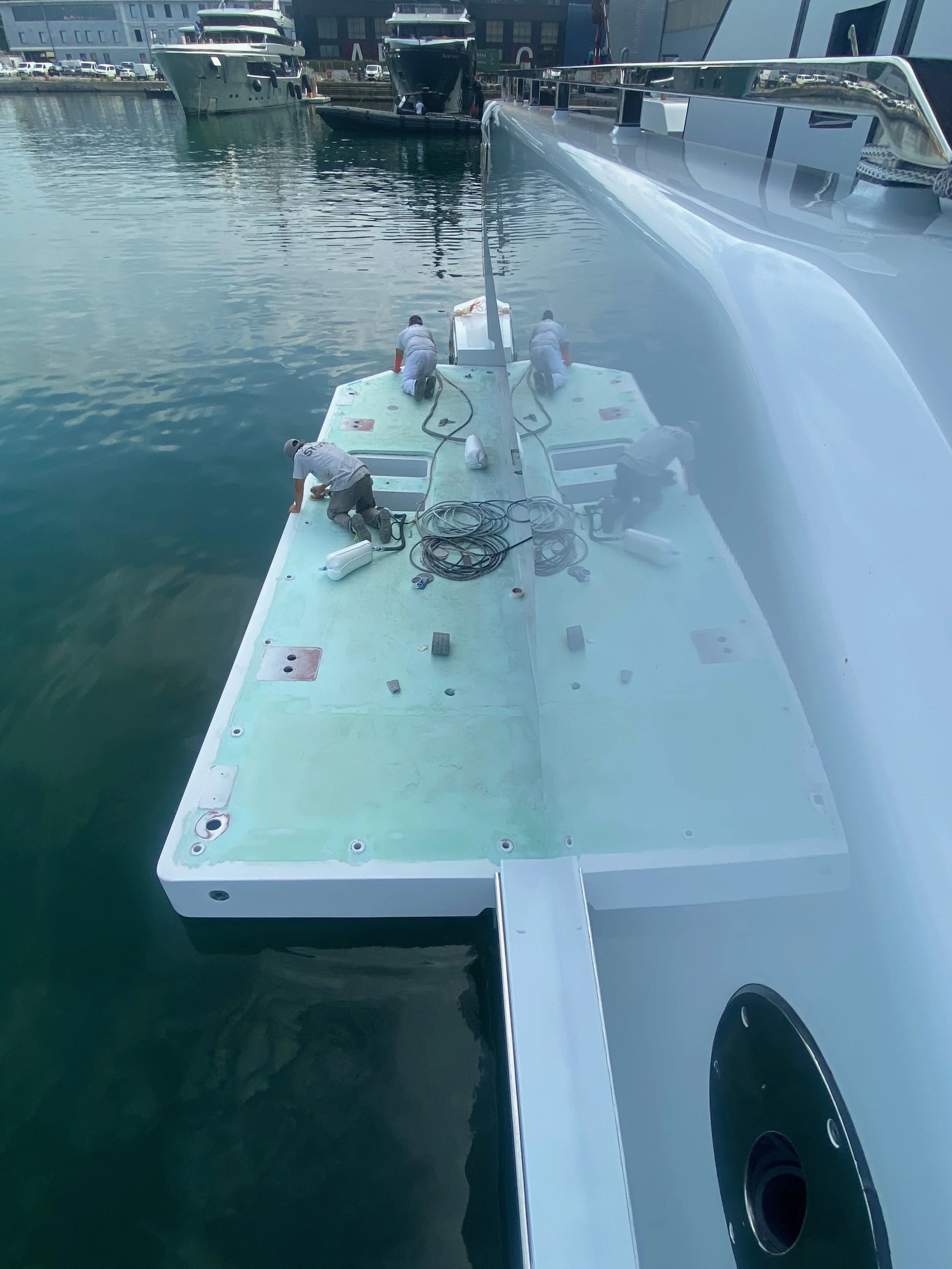

Standing water on the metal deck, scupper has not been connected, yard will correct.

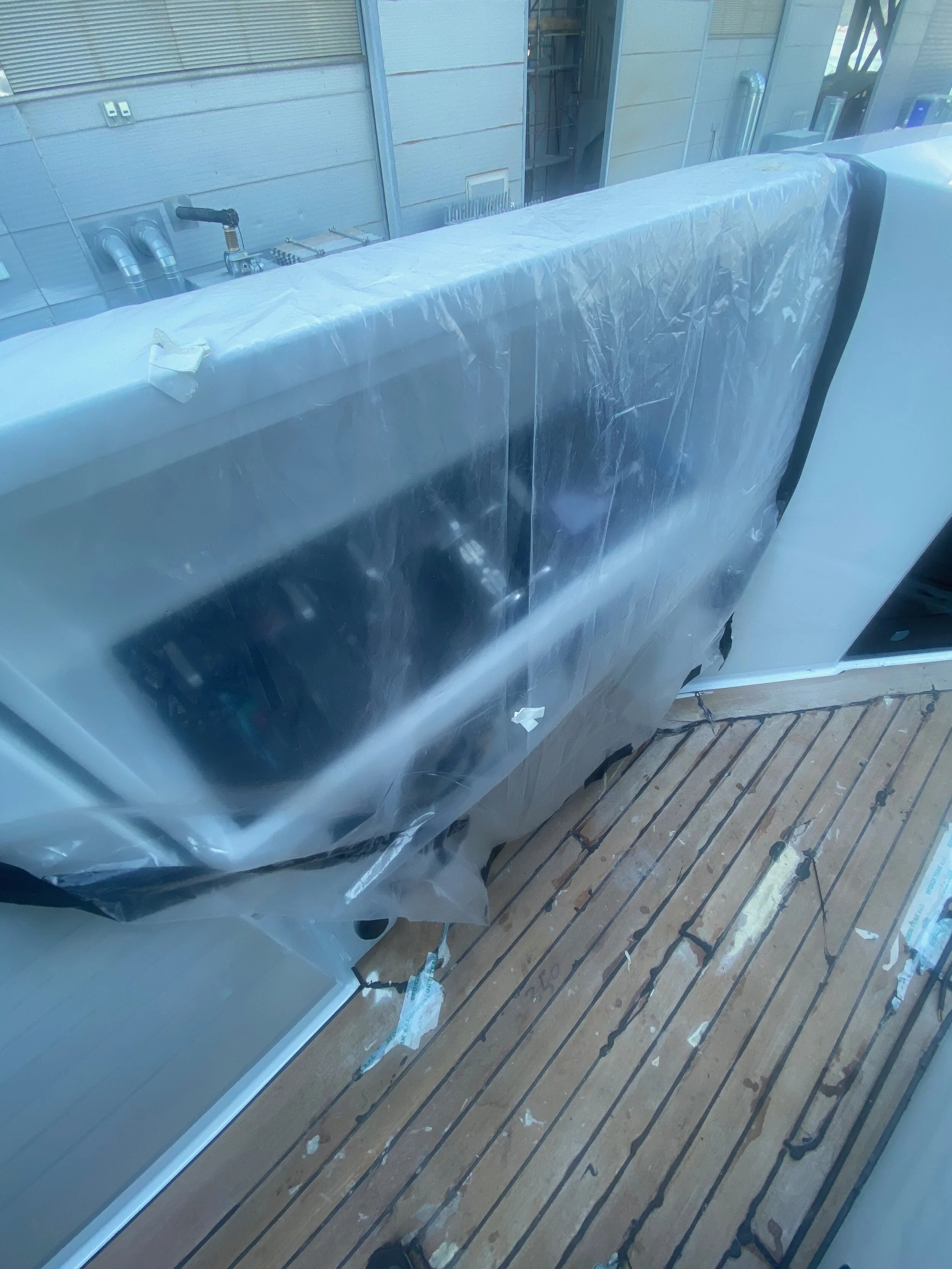

Protection on the painted surfaces

Forward rails extended on the bow area

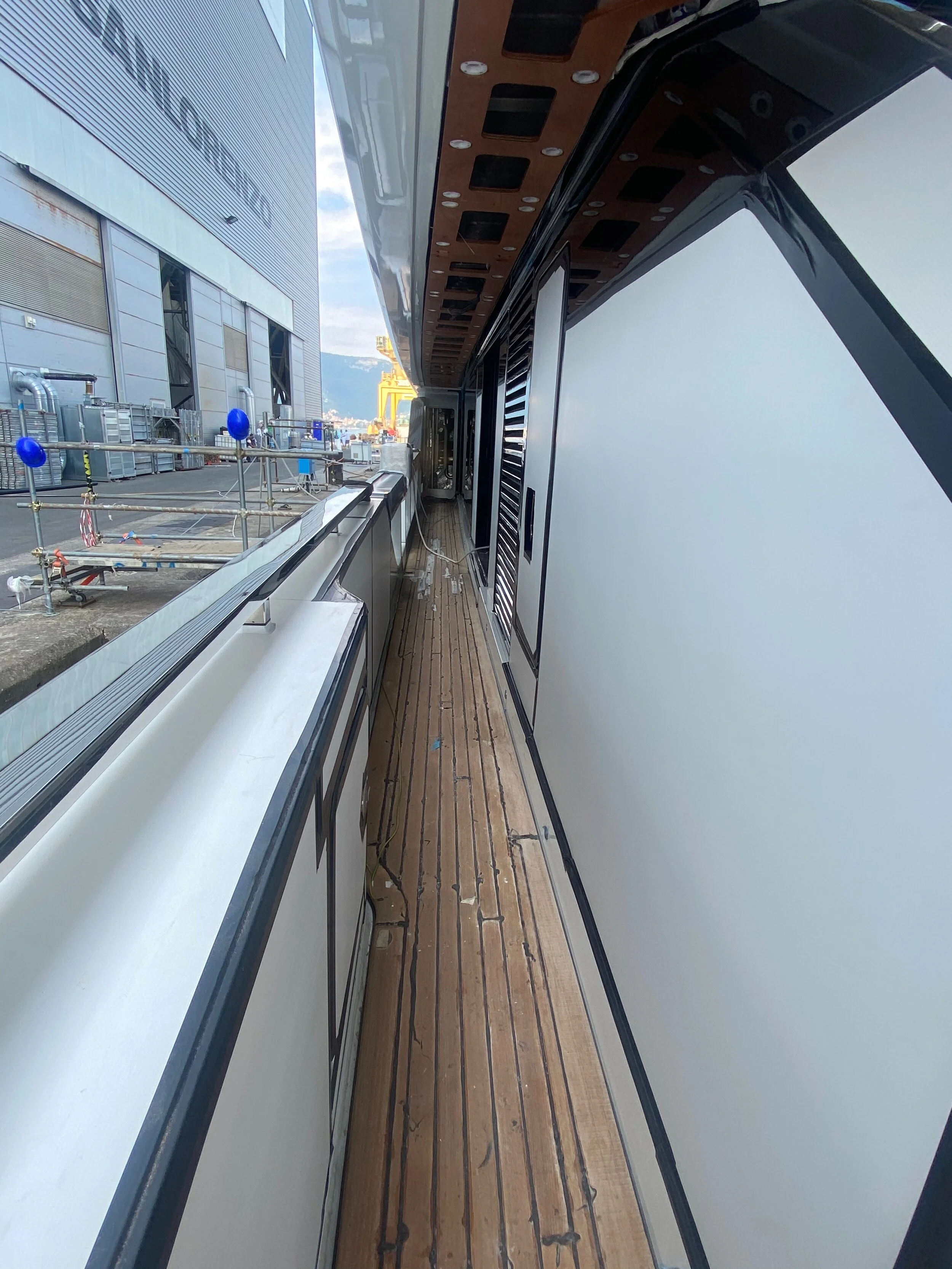

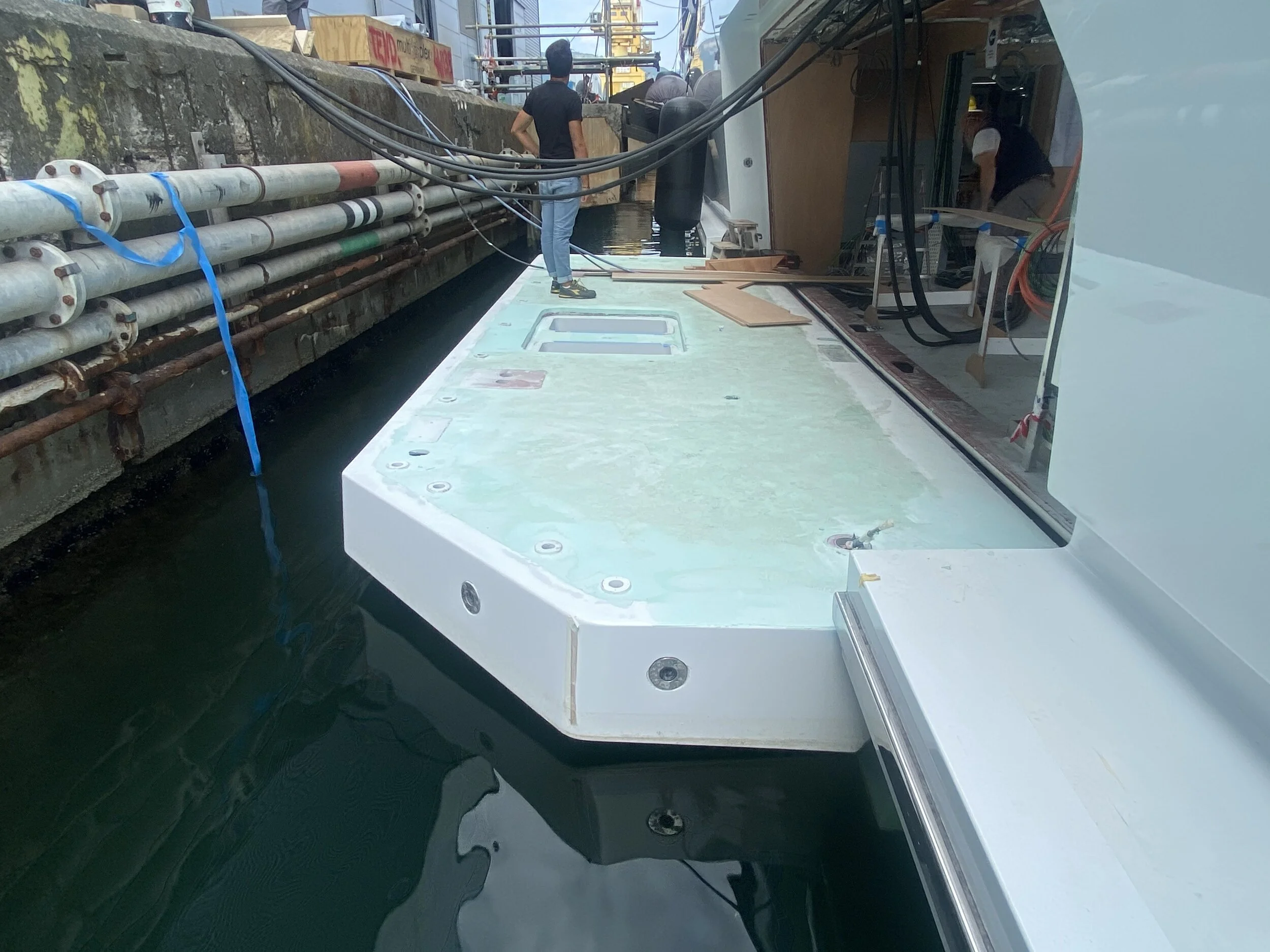

Clearance of the door to the water

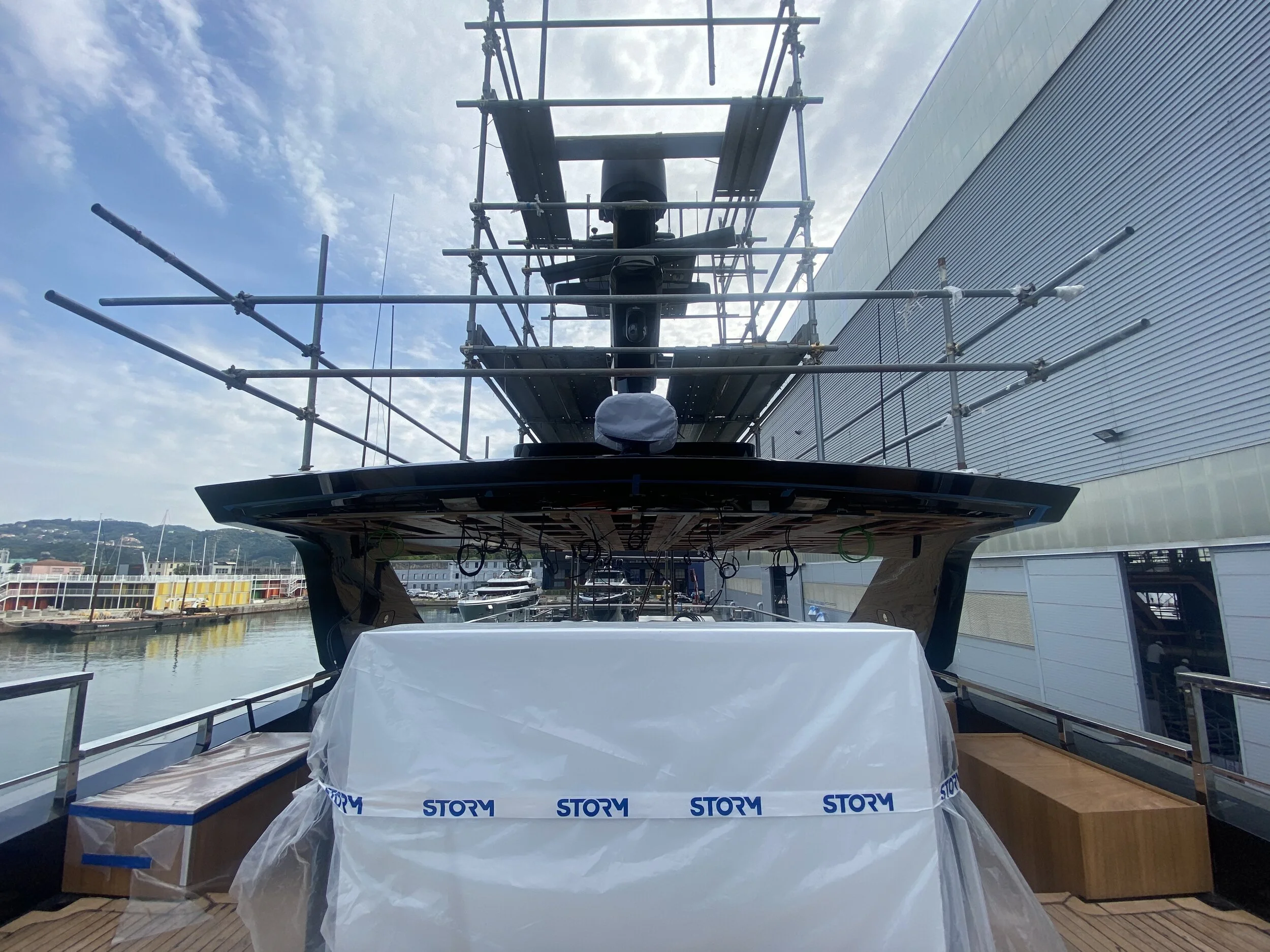

Work on the mast continues

Work on the mast continues

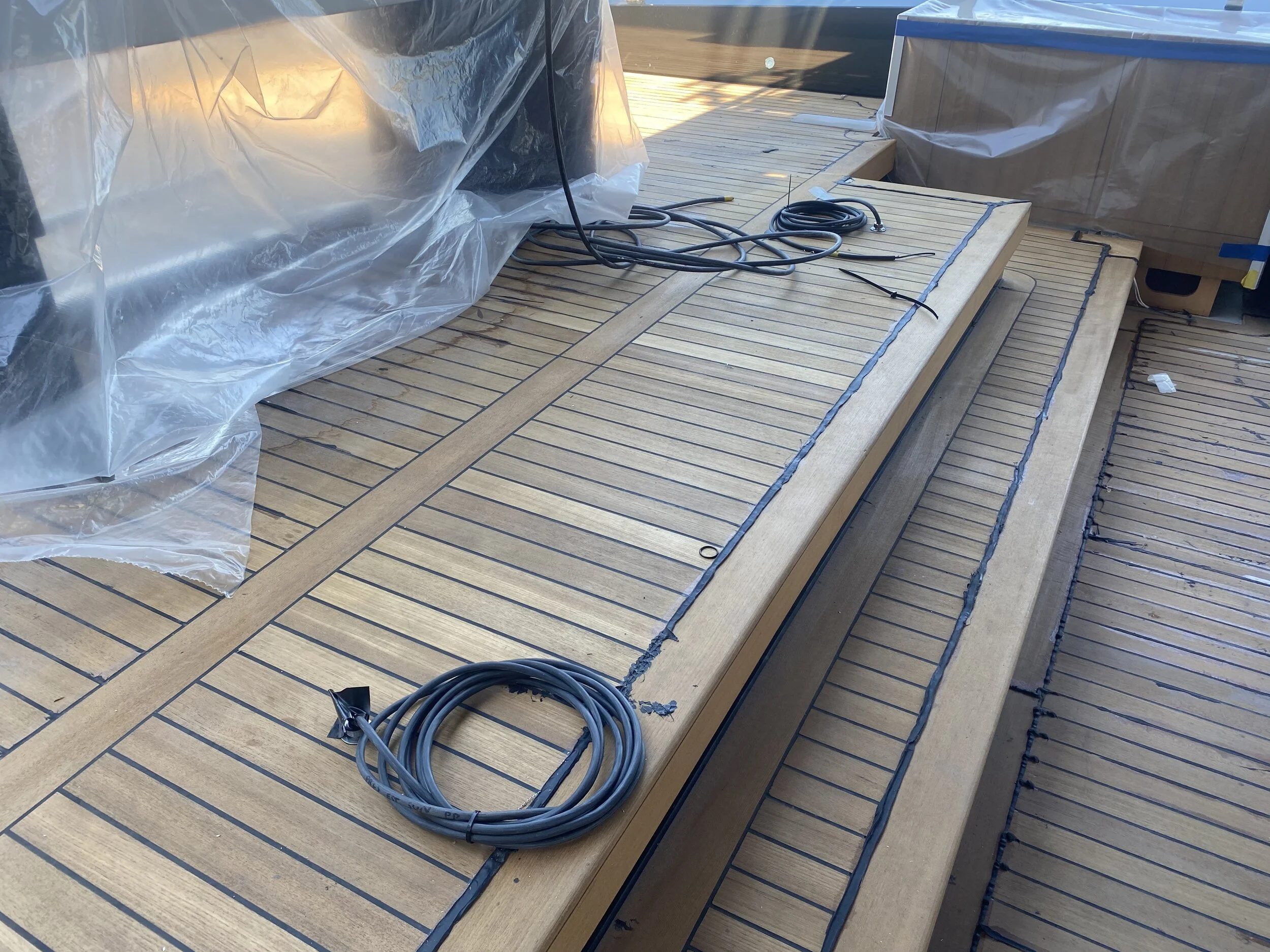

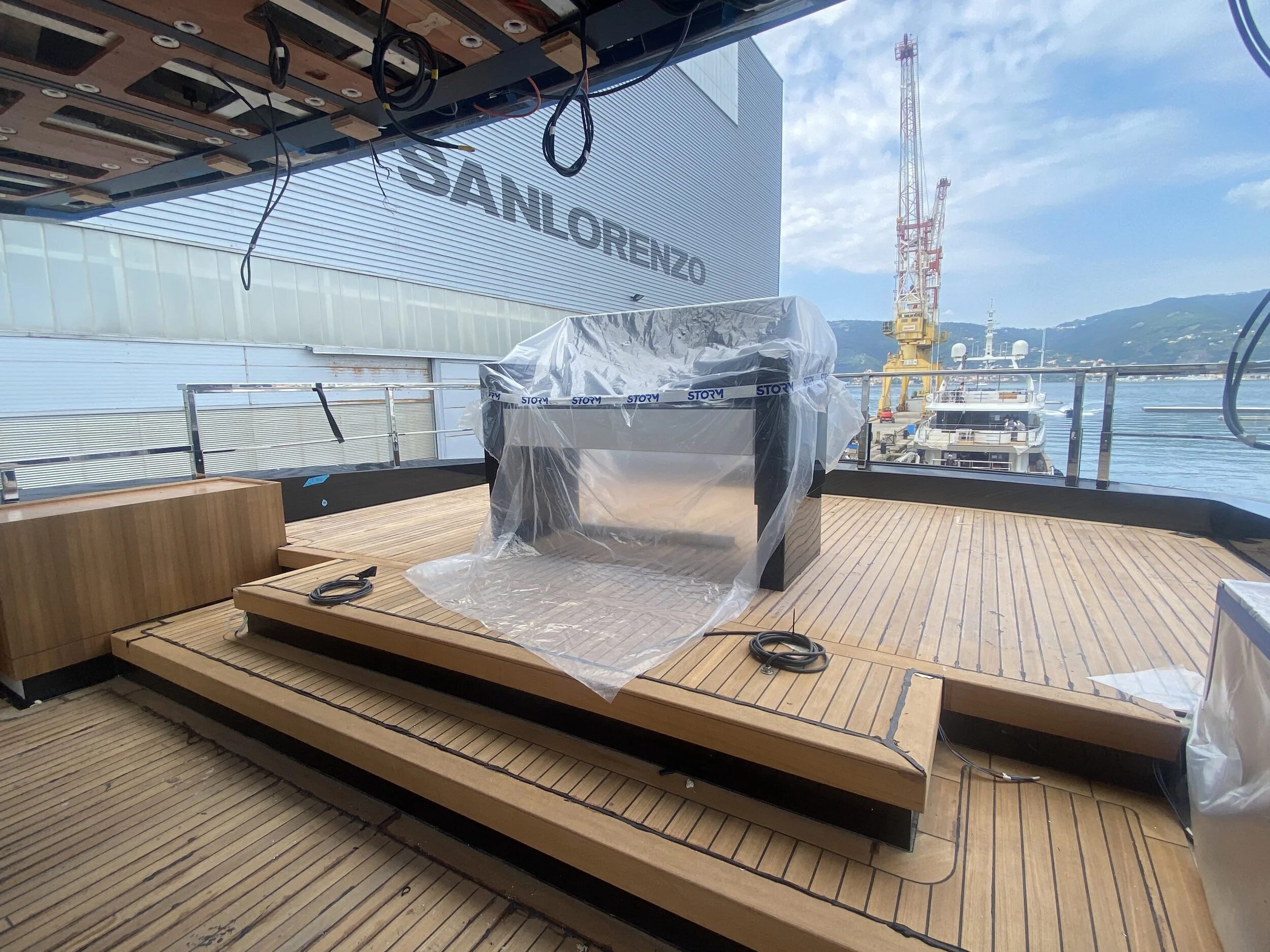

Glass panel in Jacuzzi yet to be installed

Seat or similar to be installed

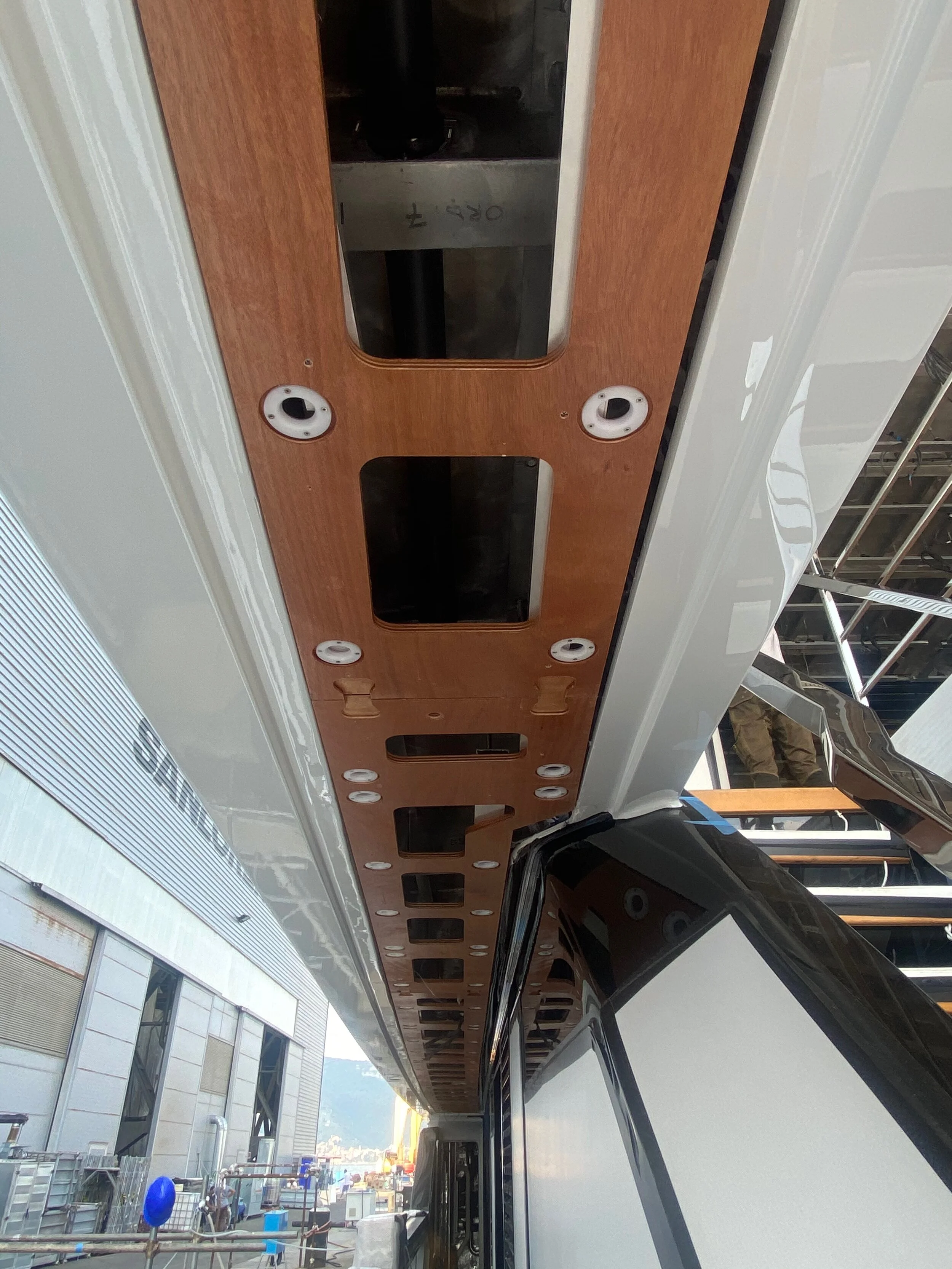

Deckhead mounts installed

Fairing and paint work continues in the beach club area

Passeralle installed

Sun deck helm installed

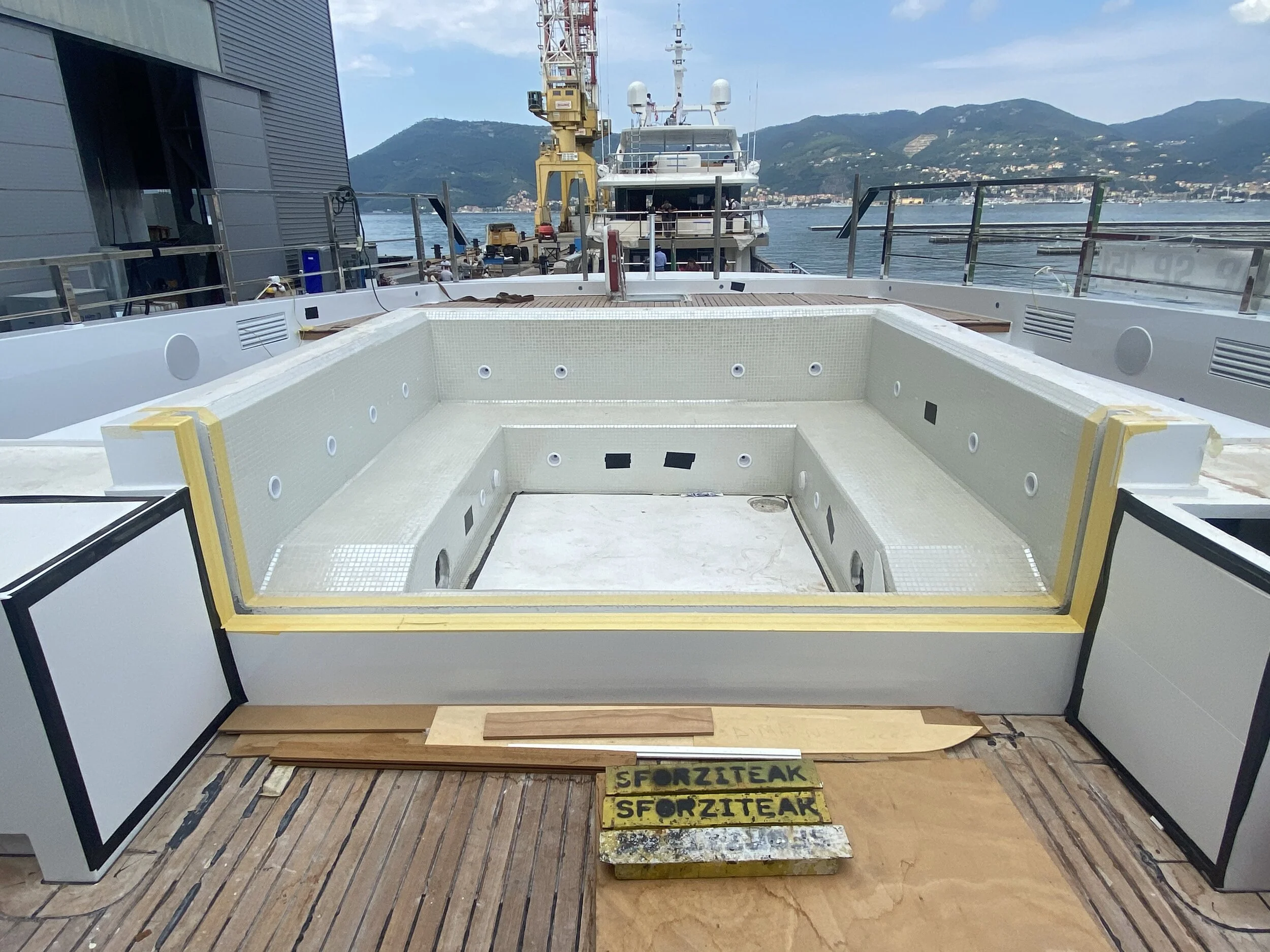

Tiling completed and Jacuzzi plumbing being installed
