Progress Report #10 | March 2023

Introduction

There is a decent pace going now and one can see the various changes and progression of the project.

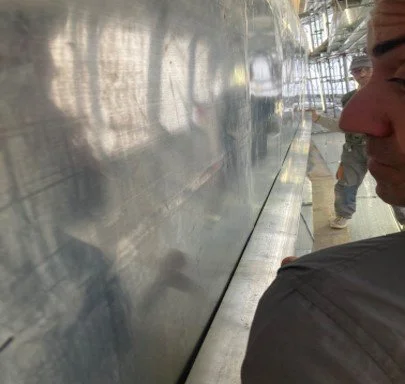

The metal primer on the Hull is at a good stage and the filling and primer in the roof area/roll bar are impressive.

Metal works and frame installation are constant throughout the Engine room, mooring stations and beach club predominantly.

Pipe work, insulation works, sound dampening and hot works are ongoing. There is an increased intensity in the wiring programme specifically in the Engine room.

We pay great attention to the insulation work as it will be a major factor in the Owner’s enjoyment going forward and I report it is being done correctly and with precision.

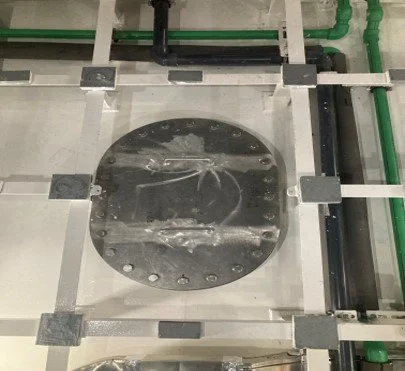

Part 2 of the welding deflection tests on the hull was carried out by San Lorenzo and witnessed by Harry Noonan, Arrow PM.

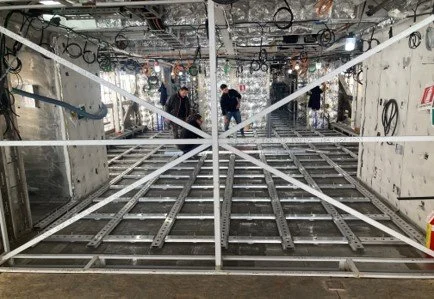

It is always nice to see the base floor going in. It is a sign of progress indeed.

HULL

IMAGES RELATE TO THE DEFLECTION TEST WHICH WAS CARRIED OUT IN TWO SESSIONS THIS MONTH

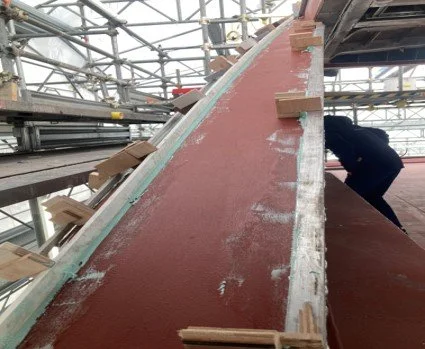

BELOW: RUBBING STRAKE REINFORCED PLATES ON TRANSOM AND HULL.

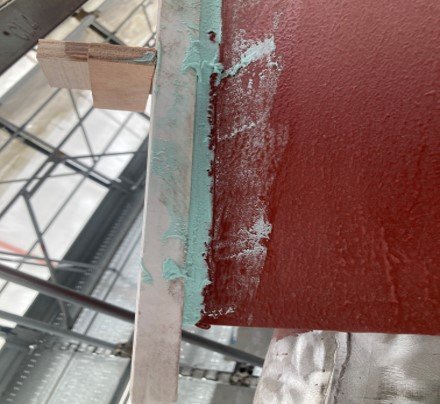

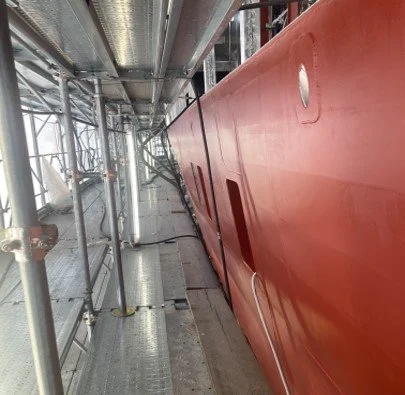

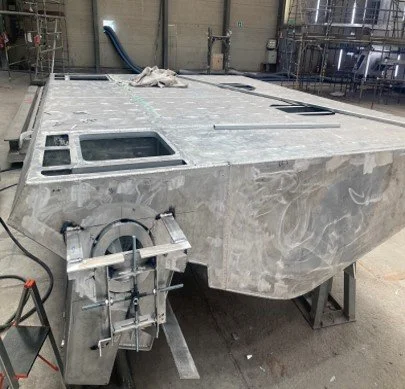

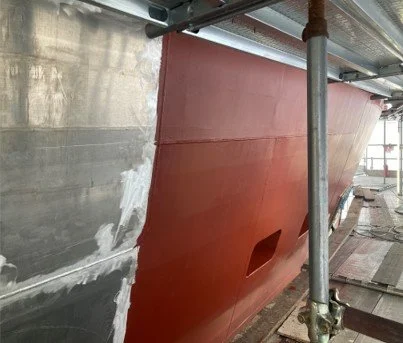

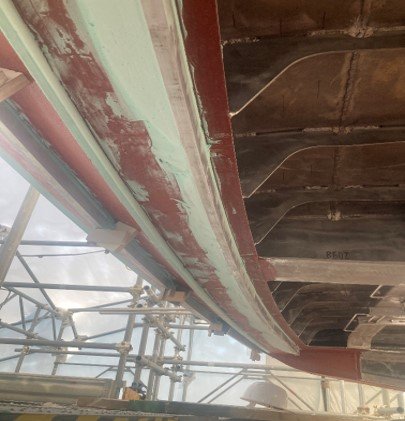

RIGHT: PRIMER COMPLETE ON 75% OF HULL AREA.

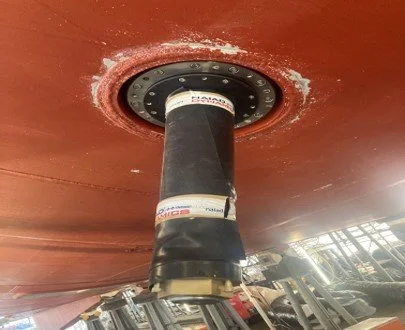

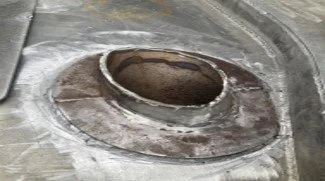

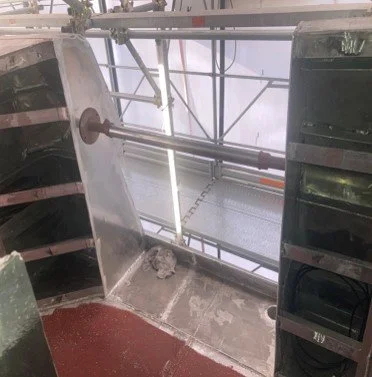

BELOW: NAIAD STABILIZER FIN SHAFT

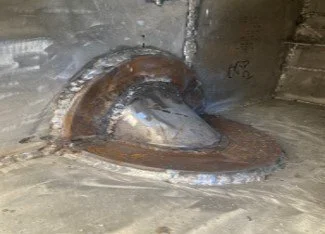

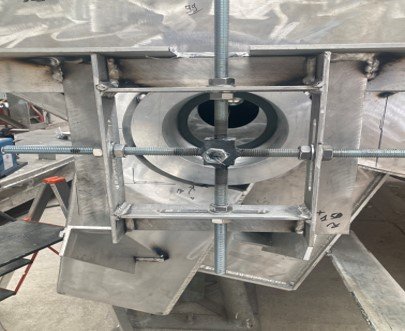

RIGHT: MOORING WHIP INSERT HULL SIDE

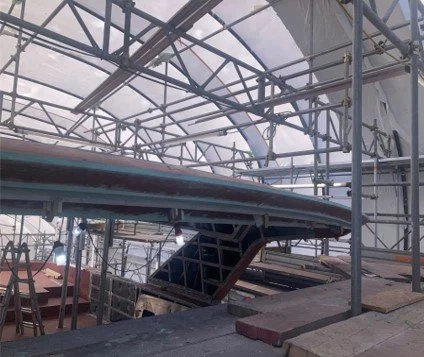

HULL/TRANSOM

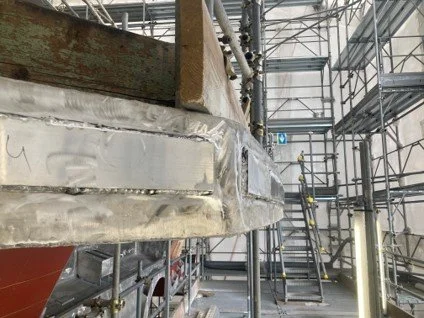

IMAGES RELATE TO WELDED DOOR-STOPPER/LIMITER FOR TRANSOM DOOR

MAIN DECK AFT

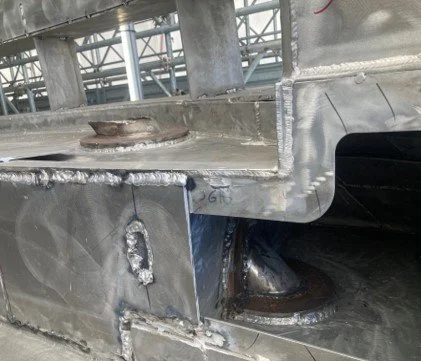

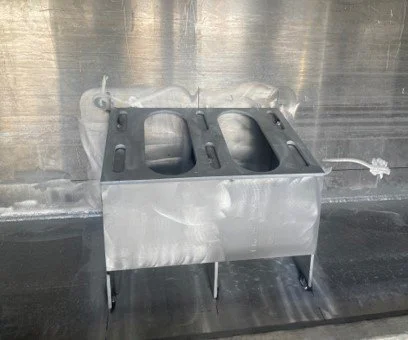

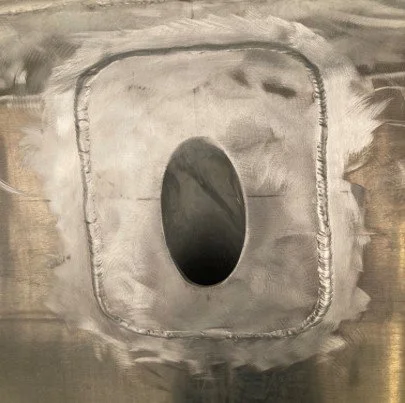

STAINLESS STEEL INSERTS FOR ROPE LEADS. WELDED TO ALUMINIUM SUPERSTRUCTURE.

SUN DECK

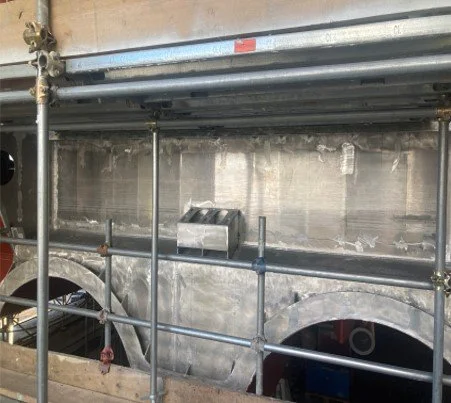

EPI –LITE FILLER ON SUNDECK ROLL BAR BEGINS

SUN DECK CONT’D: EPI –LITE FILLER PROGRESSION CONTINUED

CUTOUTS FOR LIFE RAFTS

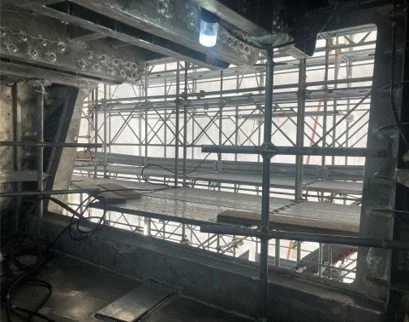

WHEELHOUSE/UPPER DECK

BELOW: FIRE HYDRANTS BEING INSTALLED

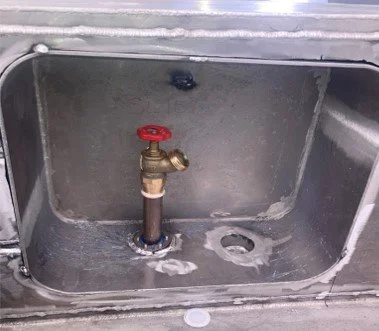

RIGHT: VENT GRILL FOR GMDSS BATTERIES

MOORING STATION/ANCHOR CHAIN LOCKERS

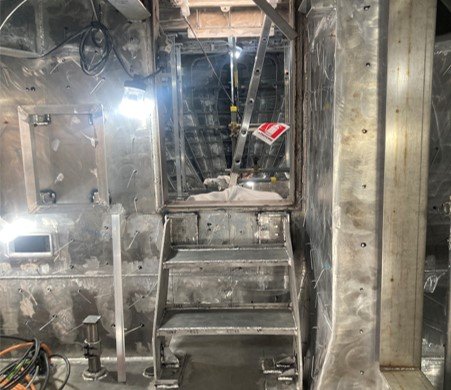

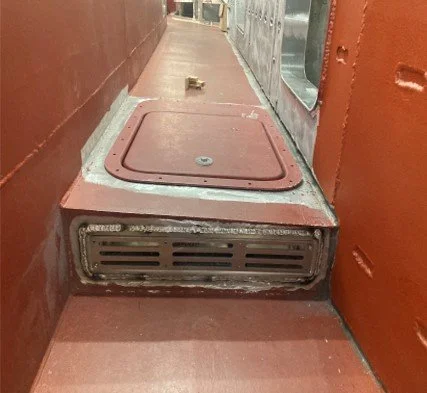

BELOW: STATION VIEWING HATCH INSTALLED

RIGHT: ANCHOR CHAINLOCKER  STRB SIDE

GALLEY

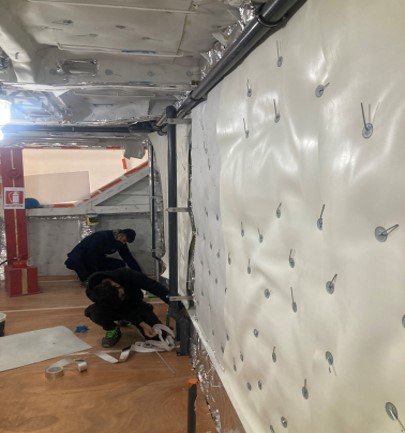

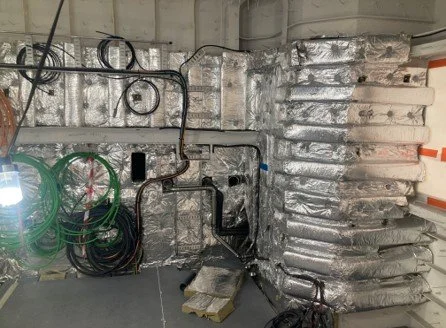

BELOW: ROCKWOOL/INSULATION AT 90%

RIGHT: EXTRACTION DUCTING IS NOW FITTED

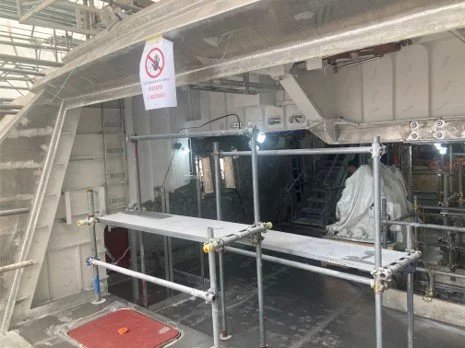

TENDER GARAGE MAIN DECK

BELOW: GARAGE SHELL DOOR REMOVED FOR WORKS.

RIGHT: STAIRWELL TO MOORING STATION FWD

OWNER OFFICE AREA

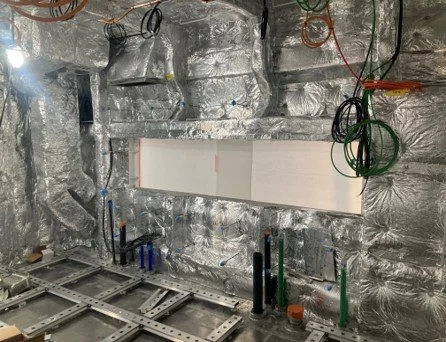

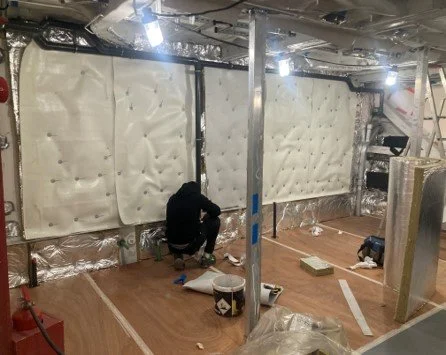

BELOW: EXAMPLE OF INSULATION IN PLACE

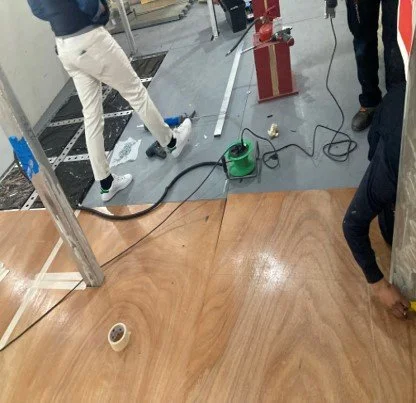

RIGHT: MARINE PLY FLOOR IN PLACE (GREY PAINT)

OWNER’S CABIN

MARINE PLY FLOOR BASE IS NOW IN POSITION AND INSULATION WORK ONGOING

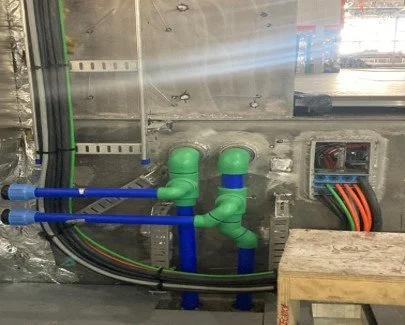

BELOW: NEAT WIRING AND PIPING WORKS

RIGHT: CLEAR RESIN FLOOR IS FOR THE BATHROOM AREA. IT ACTS AS A WATER-PROOFING

MAIN DECK SALON

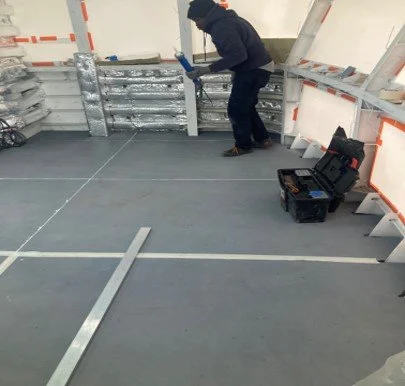

BELOW: FRAMEWORK FOR FLOOR IN PLACE AT BEGINNING OF MONTH

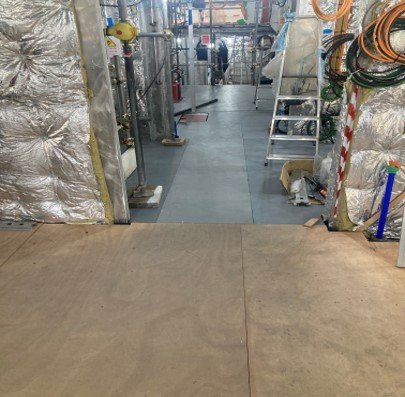

RIGHT: MARINE PLY FLOOR BASE IN PLACE IN SALON AND OWNERS CORRIDOR

 LOWER DECK GUEST BILGE AREA

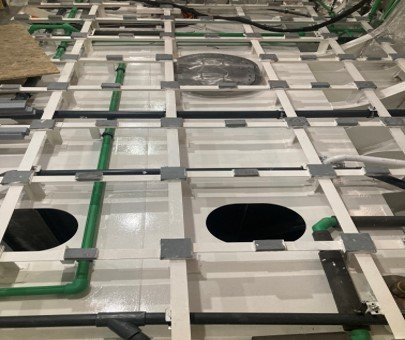

TANK TOPS PAINTED IN BOLERO DEFENDER

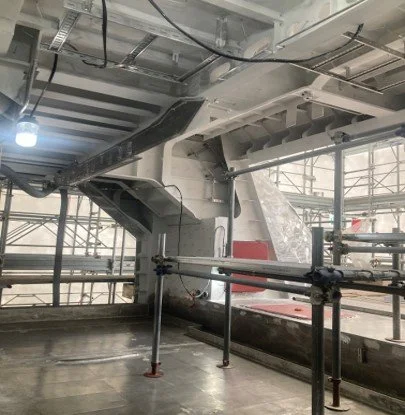

ENGINE ROOM

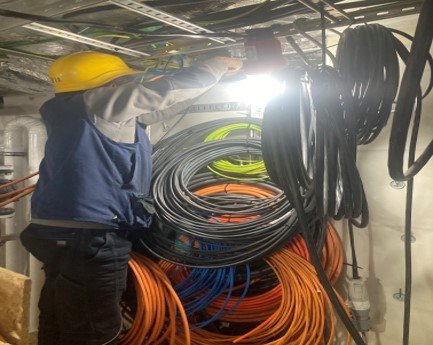

BELOW: WIRING IS MOVING AHEAD WELL

RIGHT: FUEL SIGHT GLASS IN POSITION

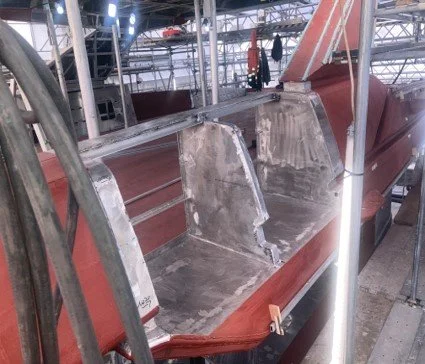

BEACH CLUB AREA

STRB SHELL DOOR REMOVED. ANTI-HUMIDITY PAINT BEING APPLIED.

TRANSOM DOOR ON YARD FLOOR

BELOW: VIEW OF PIN MECHANISM BEING FITTED

RIGHT: DOOR ITSELF IN LAID DOWN POSITION
