Progress Report #02 | Q3 2022

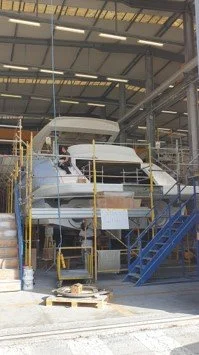

AUGUST 2022

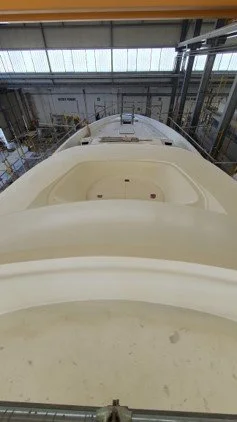

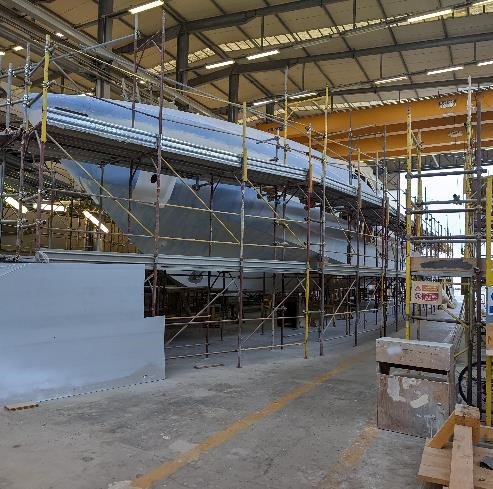

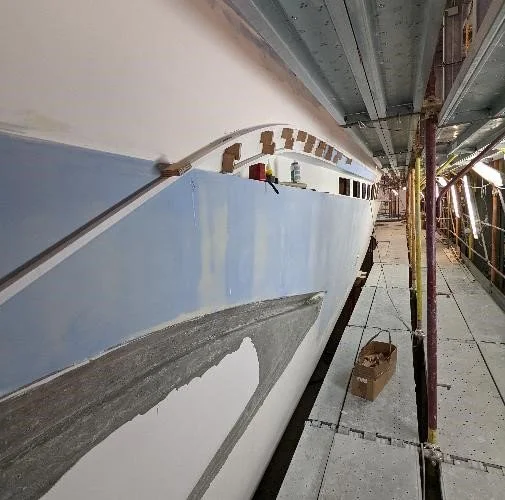

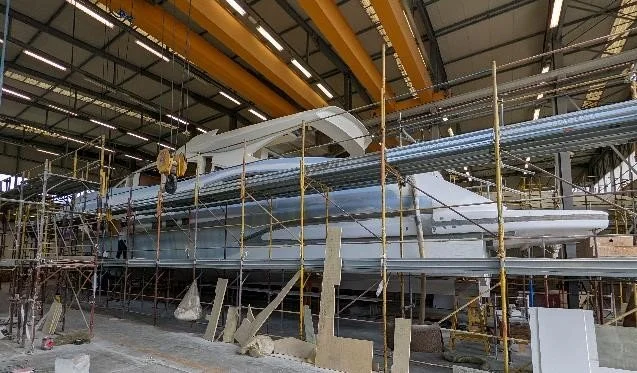

The yacht’s hull and superstructure have had a layer of gel coat applied and filler application has begun as one of the early stages of paint preparation.
Hull & Superstructure: templates are not being made for windows, vent grilles, external fittings, and brightwork. The templates will be sent to specialists for manufacturing off site.

The engine room has the machinery foundations, jet drive tunnel and engine exhaust structures installed in place.

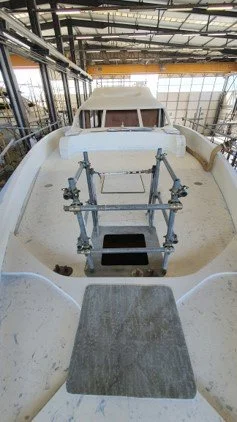

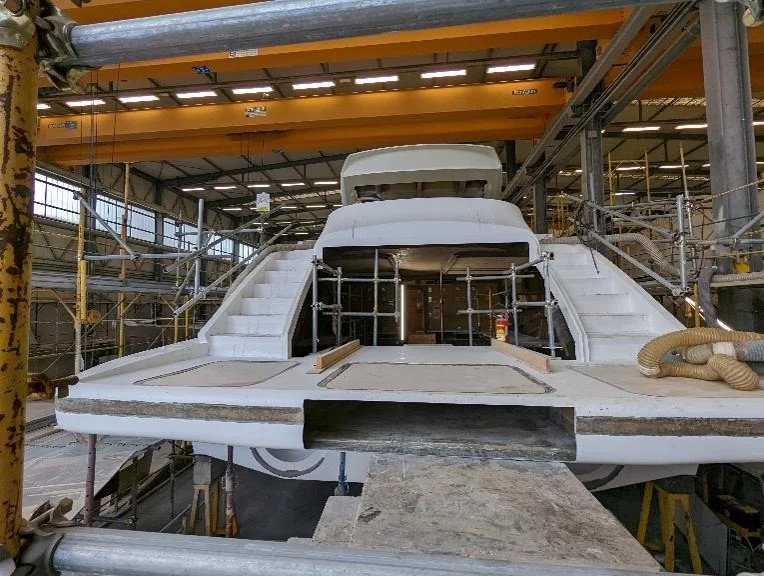

A view of the stern of the yacht, the tender bay will be fitted after the main machinery is in place.
Main deck:

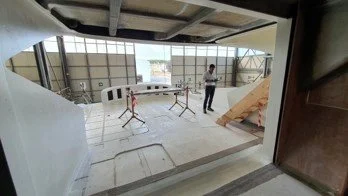

A view of the main salon is taken from the doorway leading to the bridge.
Facing forward from the same location, a view of the navigating bridge and the stairs leading down to the owner and guest accommodation
Owner’s area:
Owner's cabin along with the owners' heads.
Owner's cabin along with the owners' heads.

Guest and VIP cabins: a view of the forward VIP and guest cabins.

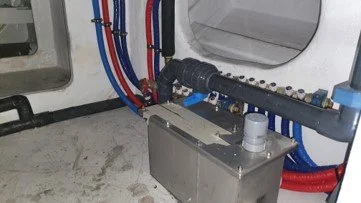

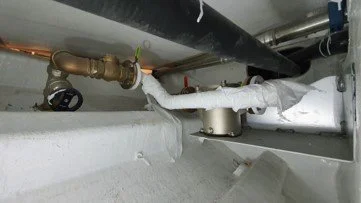

The pipework necessary for the ship’s systems that run under the floor has been installed. Including but not limited to air conditioning, hot and cold fresh water, and drainage.
The tanks for waste, fuel, and water that are under the floors have all been pressure tested and witnessed by the classification society.
Crew areas and galley

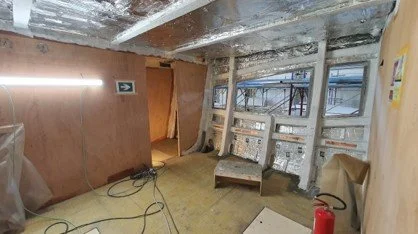

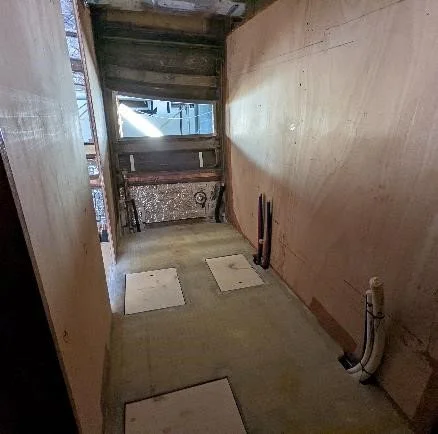

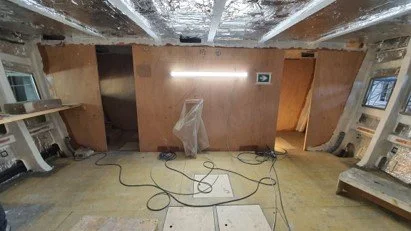

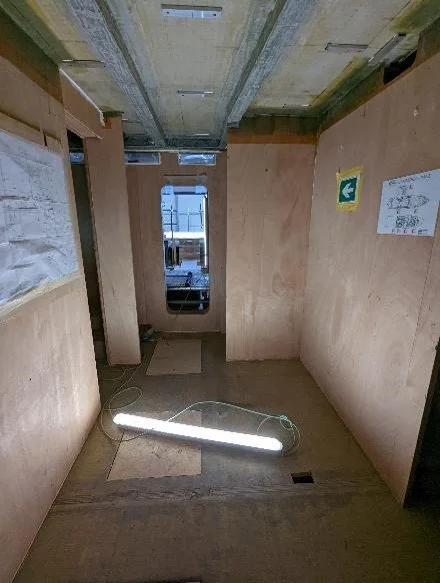

The wooden partitions are being installed that create the different areas and cabins.

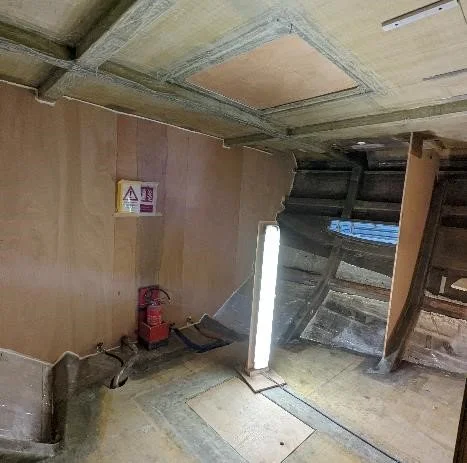

Like the guest areas, the pipework and amenities that run under the floor have been installed ant the structural tanks have been pressure tested.
SEPTEMBER 2022

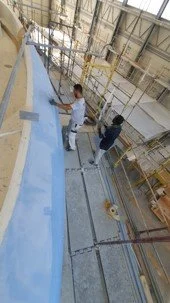

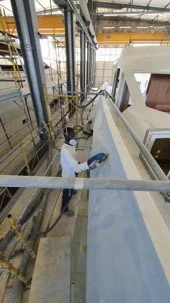

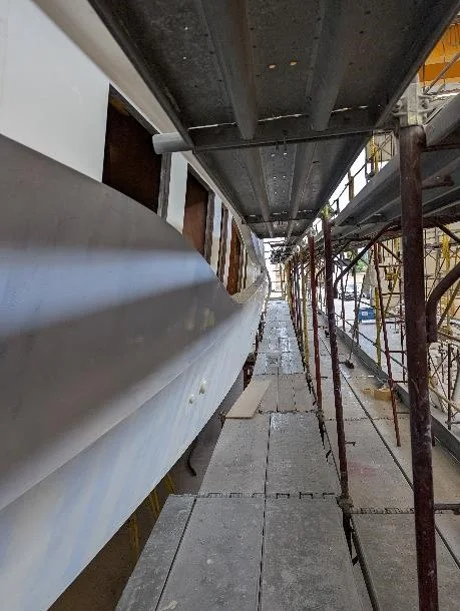

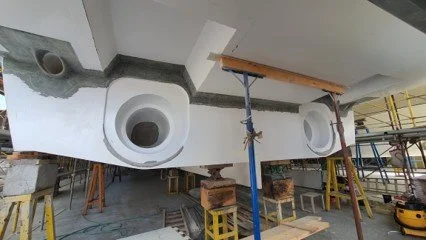

The external hull continues to be faired and sanded smooth by teams of workers on both sides of the vessel.
Superstructure

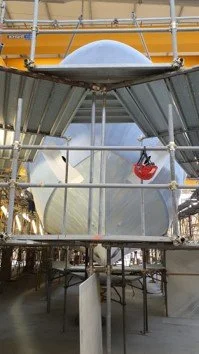

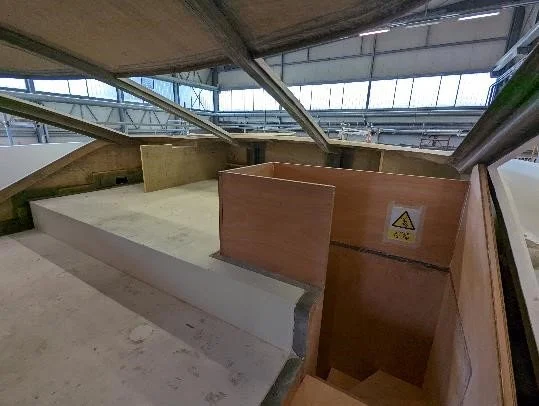

View looking forward from the Flybridge
View looking Aft from the Foredeck
Engine Room

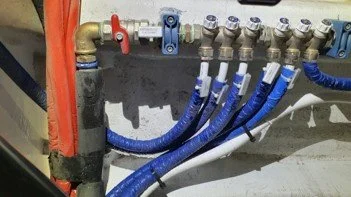

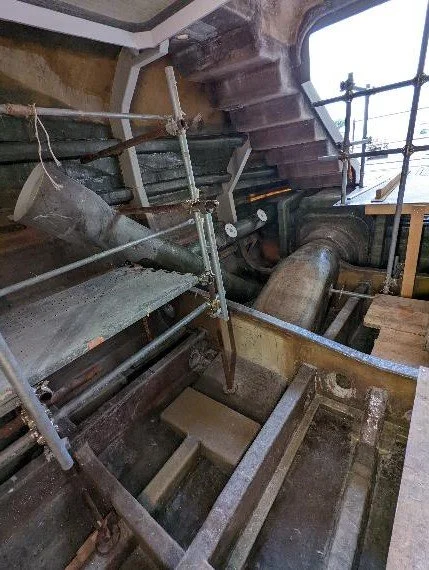

There has been little change inside the Engine Room this month as works have been continuing in other areas forward with pipe runs for the Fresh Water, Sea Water, and Fuel systems.

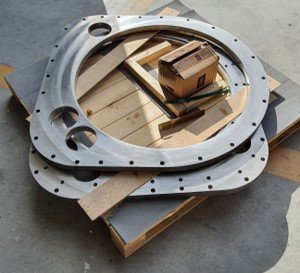

Underwater Transom - Reinforcement plates delivered today will be placed on the outside of the hull where the waterjet units bolt through the hull transom. These give strength to the hull form and provide alignment for the steering and ahead/astern hydraulic pistons.
Main Deck
View looking Aft from the Bridge area
View looking Aft from inside the Salon out over the Aft deck
View looking forward inside the Main Salon from the Aft Deck
Owners’ Cabin
Left doorway seen here leads to the master Bathroom, the doorway to the right leads to the walk in wardrobe.
View from the large hull windows in the Master Cabin
Guest and VIP cabins
Guest stairway leading forward via the corridor to the guest cabins
Entering the Forward VIP cabin
One of the guest’s cabins looking in from the corridor
Crew areas and galley

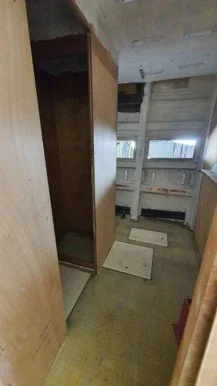

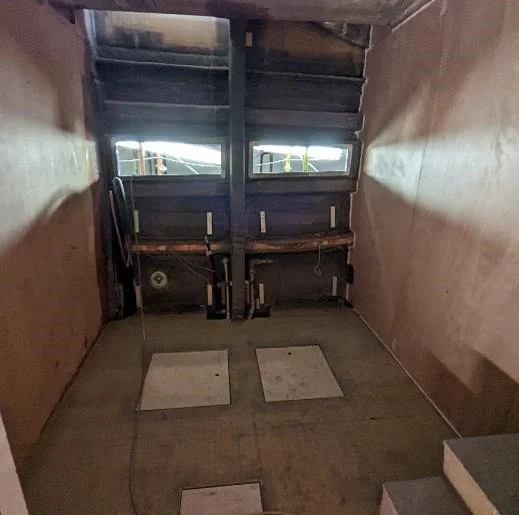

The Crew cabin bathrooms are taking shape with the shower stall completed in initial layout.

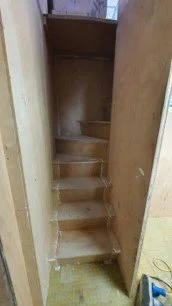

The crew area stairs have been installed
