INTERIOR
06 Dec 2022
INTERIOR PROGRESS

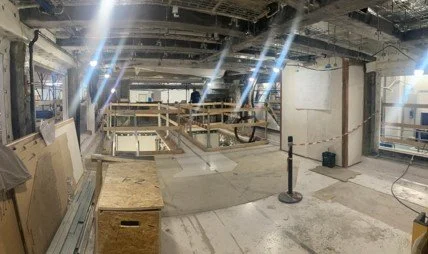

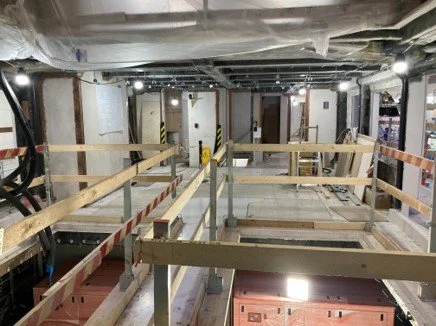

Main deck lounge
• Safety & hazard protections have been installed,
• Deck openings for engine room provide ample access for main components to be inserted in the engine room,
• Joinery (Nelson) pins have been bonded to the fiberglass structure,
• Insulation/lagging pins have been installed and lagging is in progress,
• Piping penetrations have been opened up.
Master Cabin

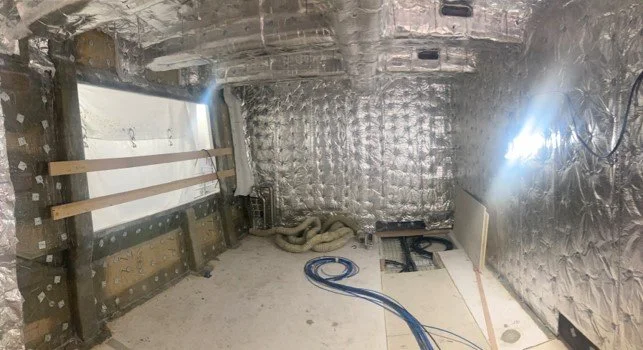

• Pins for insulation have been bonded,
• Insulation/lagging has started in these areas,
• Cables trays have been passed into these areas,
• Joinery (Nelson) pins have been bonded to the fiberglass structure,
• Compartmentation (dividing the cabin from the bathroom) is now in place,
• Flooring is in place.
Lower deck cabins

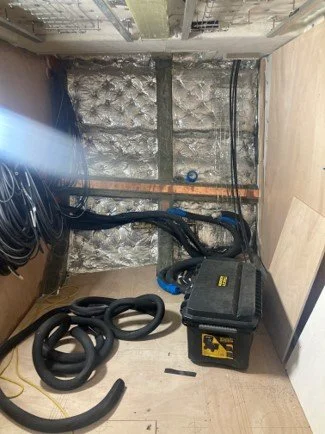

• Pins for insulation have been bonded,

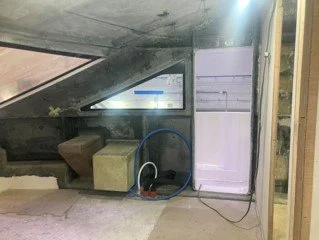

• Insulation/lagging is proceeding well and close to complete,

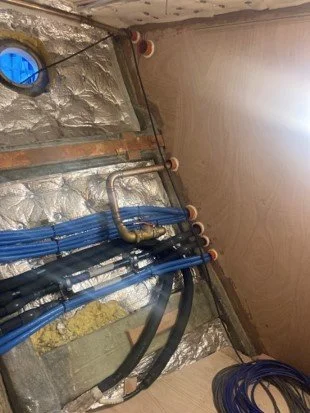

• Electrical cables and bonding plates have been routed through these areas,

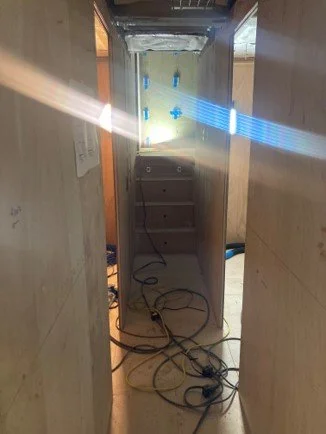

• Floors and compartmentation are being installed,

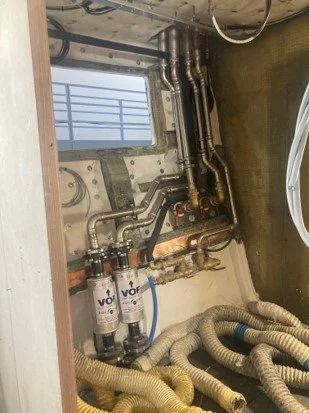

• Piping is being passed through these areas.
Lower deck cabins (part 2)
• Fin stabilizers pockets are being outfitted,
• Bulkhead penetrations are being completed.
• Piping is being routed through these areas.
• Electrical cables are being routed through these areas.
• Insulation has been installed but has also been damaged (needs to be repaired)

Bridge areas

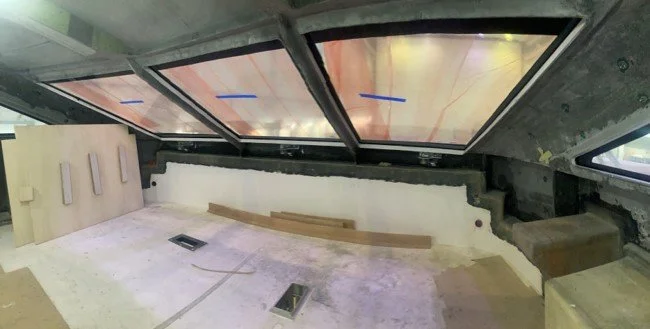

• Windows have been installed,
• Raw bulkhead separations for day head and aft salon have been installed.
Galley
• Pins and insulation have been insulated in the galley, which will provide the required B15 insulation that is required for class.
• No further significant progress can be reported in this area.
Crew areas

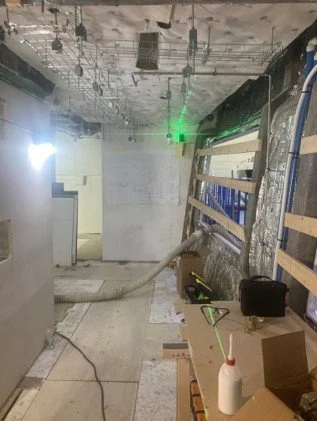

• Pins and insulation have been installed on side shell
• Piping has been routed through these areas,
• Electrical cabling has been routed through these areas and waiting for switchboards,
