Progress Report #03 | Q2 2023

Introduction

• Project 606 is currently in the hull and superstructure construction phase in AES Shipyard, Istanbul area, Turkey.

• This report shows the current status of 606 for Q2 2023.

• 606 will have the finished profile shown below on completion.

• Overall the steelwork is very good; plating is not getting ground too roughly. steel has been rolled by outside contractors, overall smooth rolls. There is one area where the steel has a large bubble which has been noted by the shipyard and OT - See # 05 below

• The steel material is bought within Turkey, and the quality is very good.

• Construction of the decks are properly constructed with the interior deck plates flat and exterior decks cambered

• There are a few areas in the bilges that need limber holes such as around the stabilizers and some stringers that will hold water.

• AES also keep their project clean and tidy

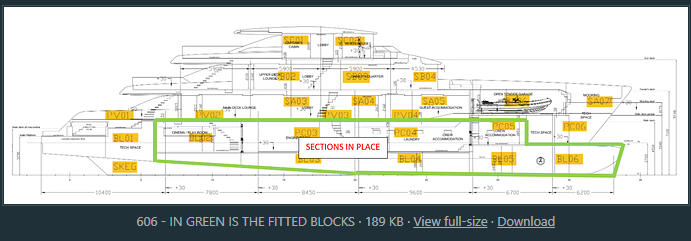

• There are many blocks under construction, you can see in the green box the blocks that are in place and the sections are welded together

BLOCK BL06

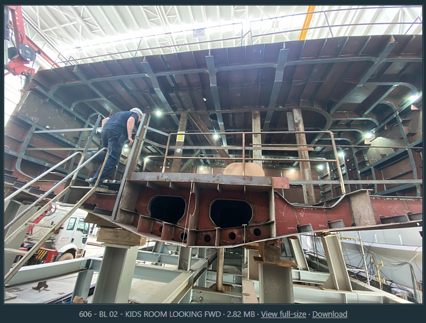

BL02 KIDS ROOM LOOKING FWD

BL02 KIDS ROOM LOOKING FWD

BL03 / PC03 - ENGINE ROOM LOOKING FWD

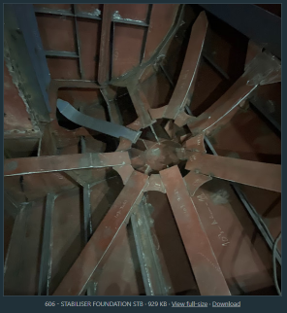

STABILISER FOUNDATION STB

STABILISER FOUNDATION STB

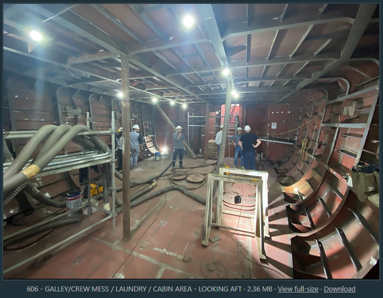

GALLEY / CREW MESS / LAUNDRY / CABIN AREA - LOOKING AFT

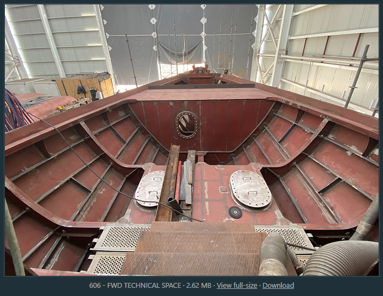

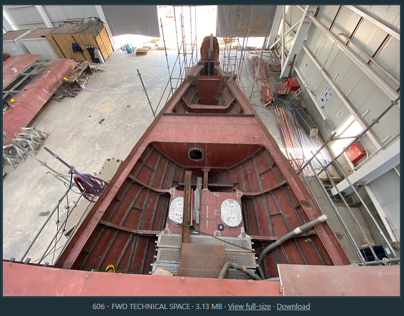

FWD TECHNICAL SPACE

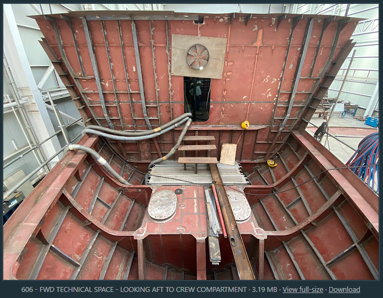

FWD TECHNICAL SPACE - LOOKING AFT TO CREW COMPARTMENT

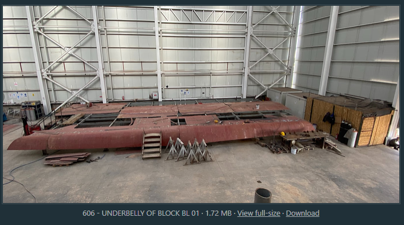

UNDERBELLY OF BLOCK BL01

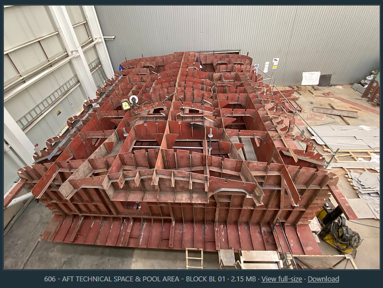

AFT TECHNICAL SPACE & POOL AREA - BLOCK BL01

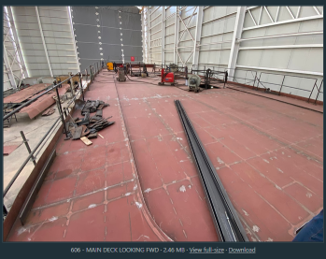

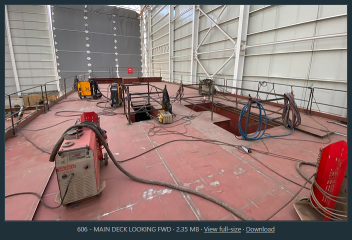

MAIN DECK LOOKING FWD

MAIN DECK LOOKING FWD

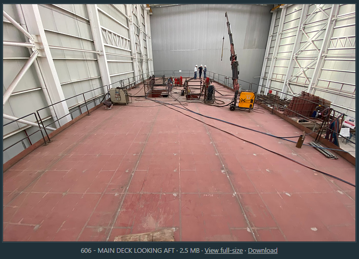

MAIN DECK LOOKING AFT

FWD TECHNICAL SPACE

BUILDING PS 05 / 06 CREW ACCOMMODATION AND TECHNICAL SPACE

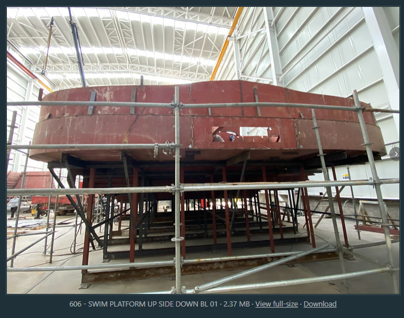

SWIM PLATFORM UPSIDE DOWN BL01
