Progress Report #02 | January 2023

Introduction

• Project 606 is currently in the hull and superstructure construction phase in AES Shipyard, Istanbul area, Turkey.

• Construction is now split between two halls within the same shipyard for block fabrication & block erection.

• This report shows the current status of 606 for the month of January 2023.

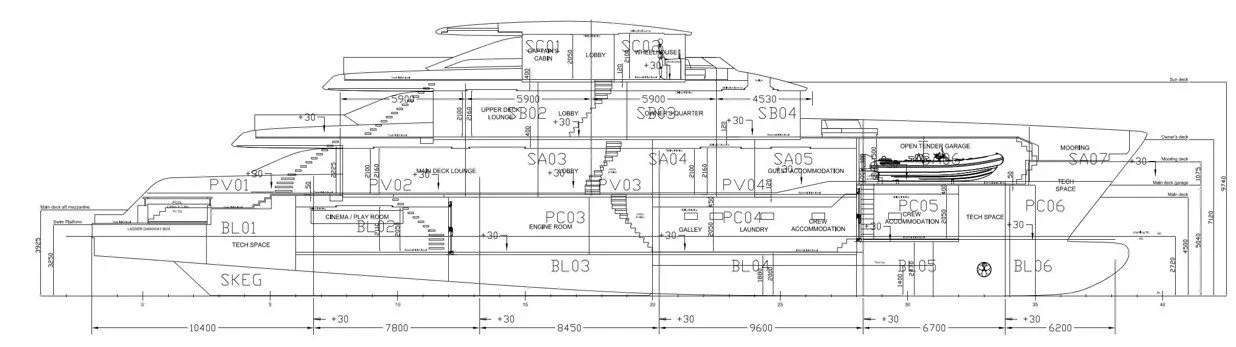

• 606 will have the finished profile shown below on completion.


• Block construction drawing shown below for reference

• BL03 shown inside the red box is in the fabrication phase.

• BL02 & BL06 are at the fabrication stage but very early, with steel cut & some internal steelwork assembled.

• BL04 & BL05 shown inside the blue box are in the erection phase.

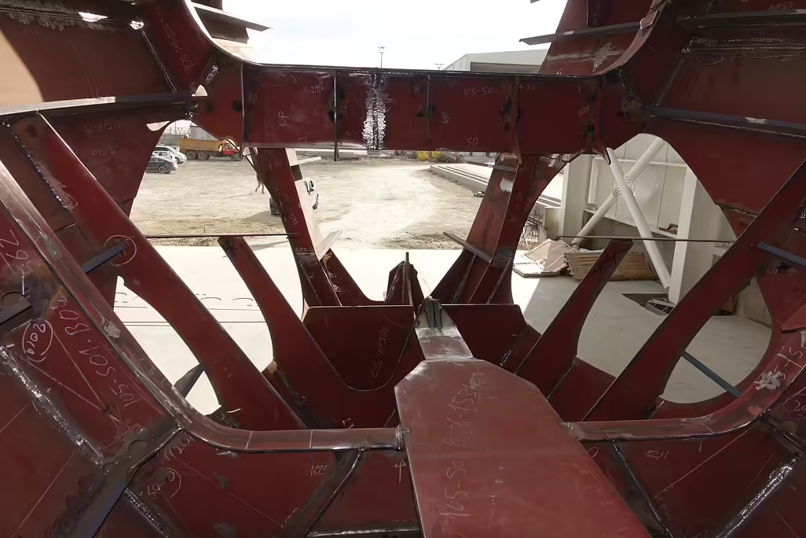

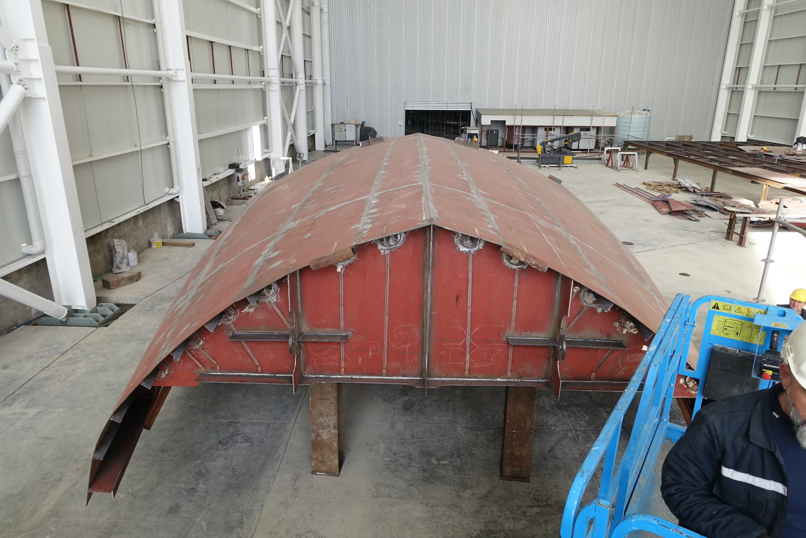

BL03 PREFABRICATION

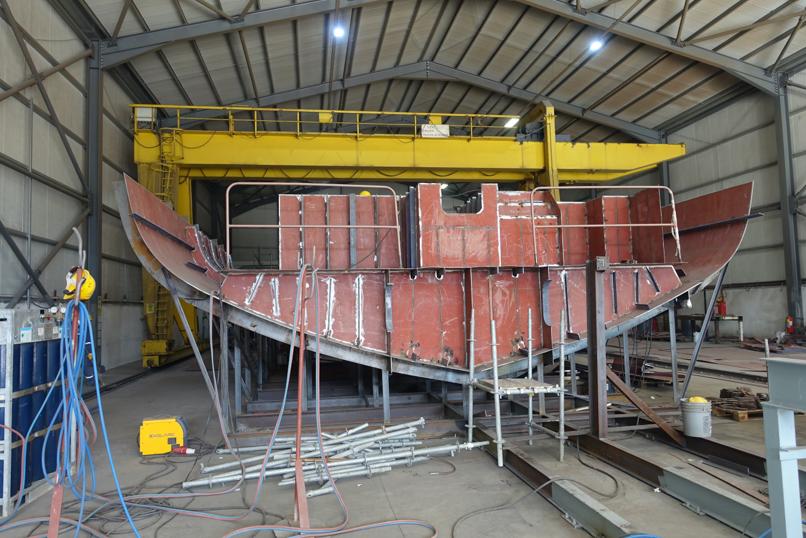

BL05 BLOCK ERECTION PREPARATION

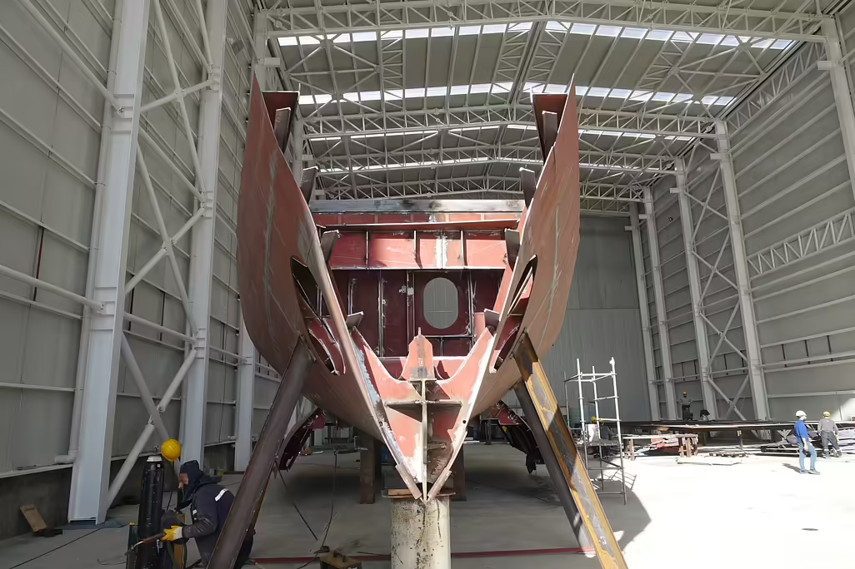

BL04 BLOCK ERECTION PREPEARATION

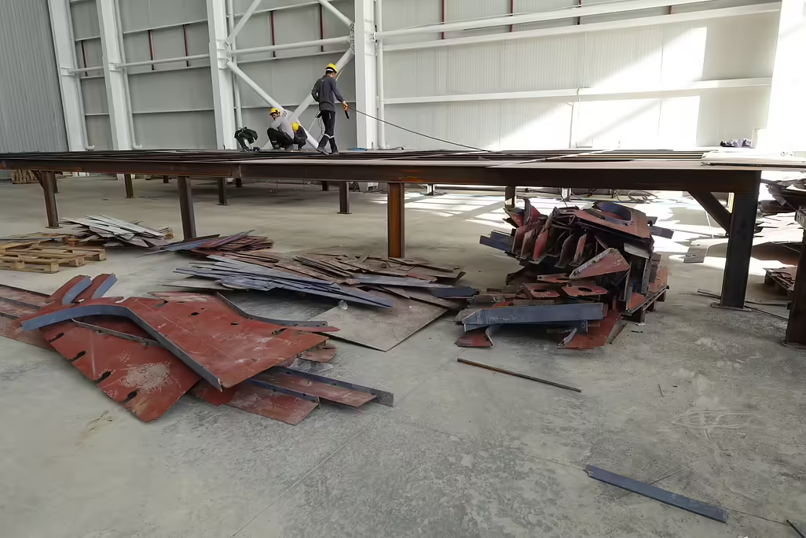

BL06 & 02 FABRICATION
